Sydney residential projects · Dated site records

10 College Crescent, St Ives · Construction progress and project evidence

Masonry, carpentry and site coordination

10 College Crescent, St Ives, NSW 2075, Australia
Reviewed: 1 October 2026 AEST · Stages reflect their dated source records

Recorded workMasonry, carpentry and site coordination
Published site photos10
Original report index3

Project rolesCase studyProgressSite photosInspectionsRectification

Project roles and responsibility

The project master reviewed on 30 September 2026 names Australian Urban Direct iBuying Pty Ltd in the Builder field. This page presents project coordination, stage records and document management within the AUD operating framework. The master field is a project record; the contract, licence and appointment documents determine construction responsibility.

Projects use their respective responsible entities. The shared management system shows operating coordination; corporate relationships and responsibility are checked against the relevant documents.

Dated construction progress

  1. Site cleaning around the masonry works recorded.

  2. Reports record carpentry and site support, including carpentry around skylights.

Case study: roof delivery, skylight framing and structural checks

For a homeowner, the practical question at this stage is when the roof and skylight openings can be made weather-tight without treating a planned delivery or a site photograph as final acceptance. The records document a change in sequence and trade coordination. No homeowner statement or complaint has been supplied for publication.

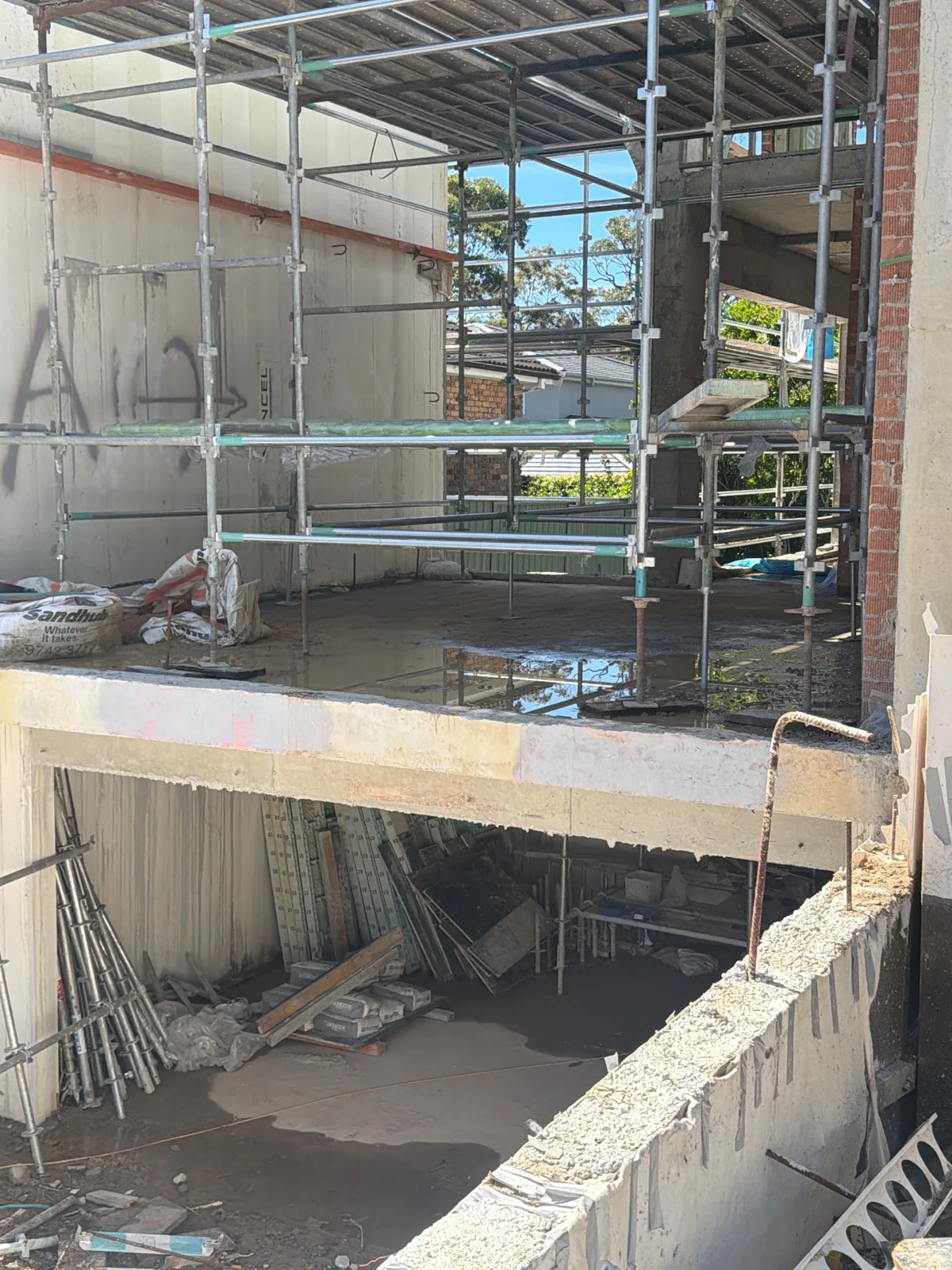

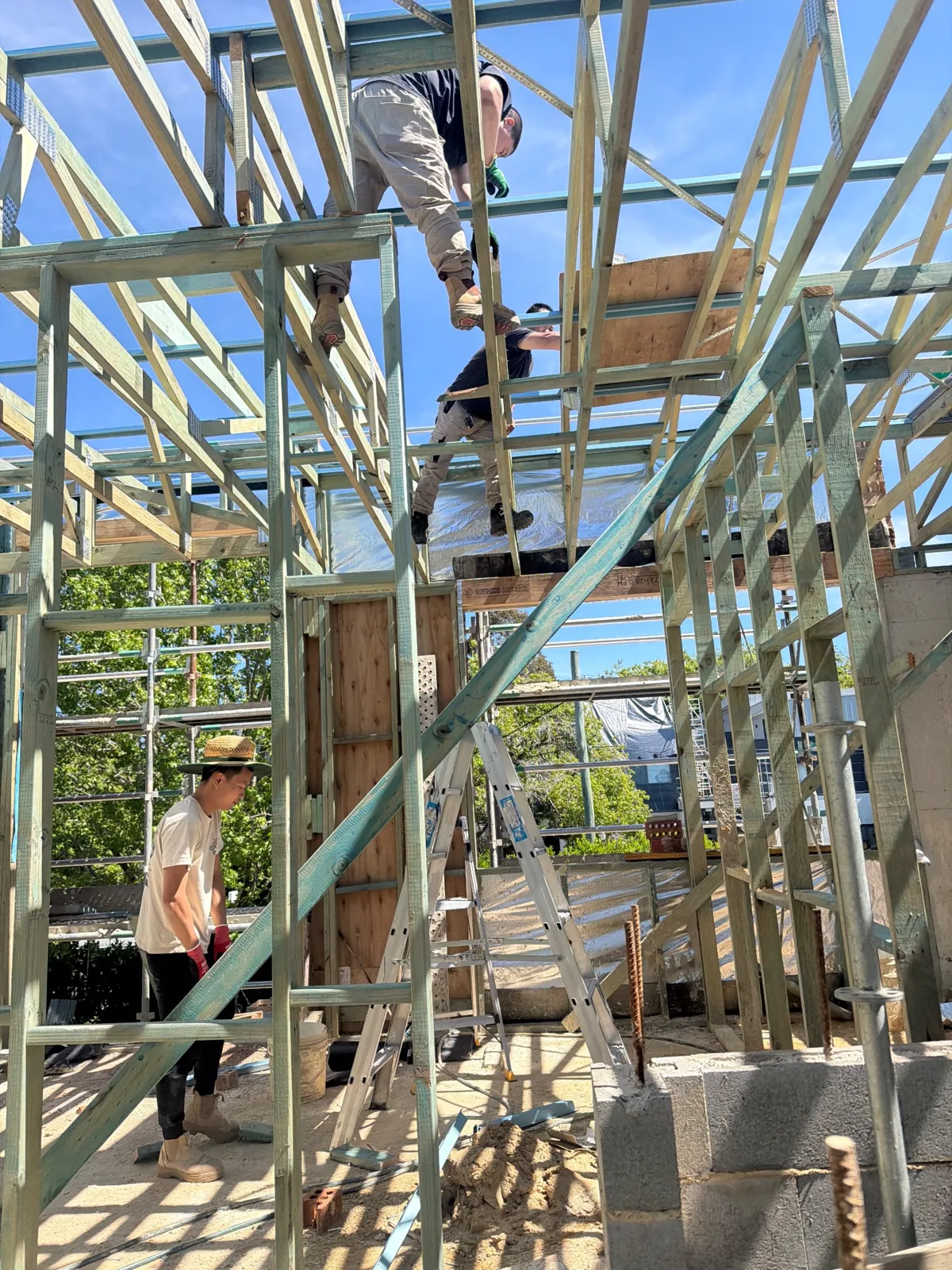

  1. The PM report records steel workers installing a beam near an upper window opening. This is a site observation, not a structural sign-off.

  2. A site voice record says roof sheets had not arrived and the roofing trade was not there; the team intended to follow up. The DingTalk schedule carried a different planned materials date, so this page uses the observed site record for actual arrival.

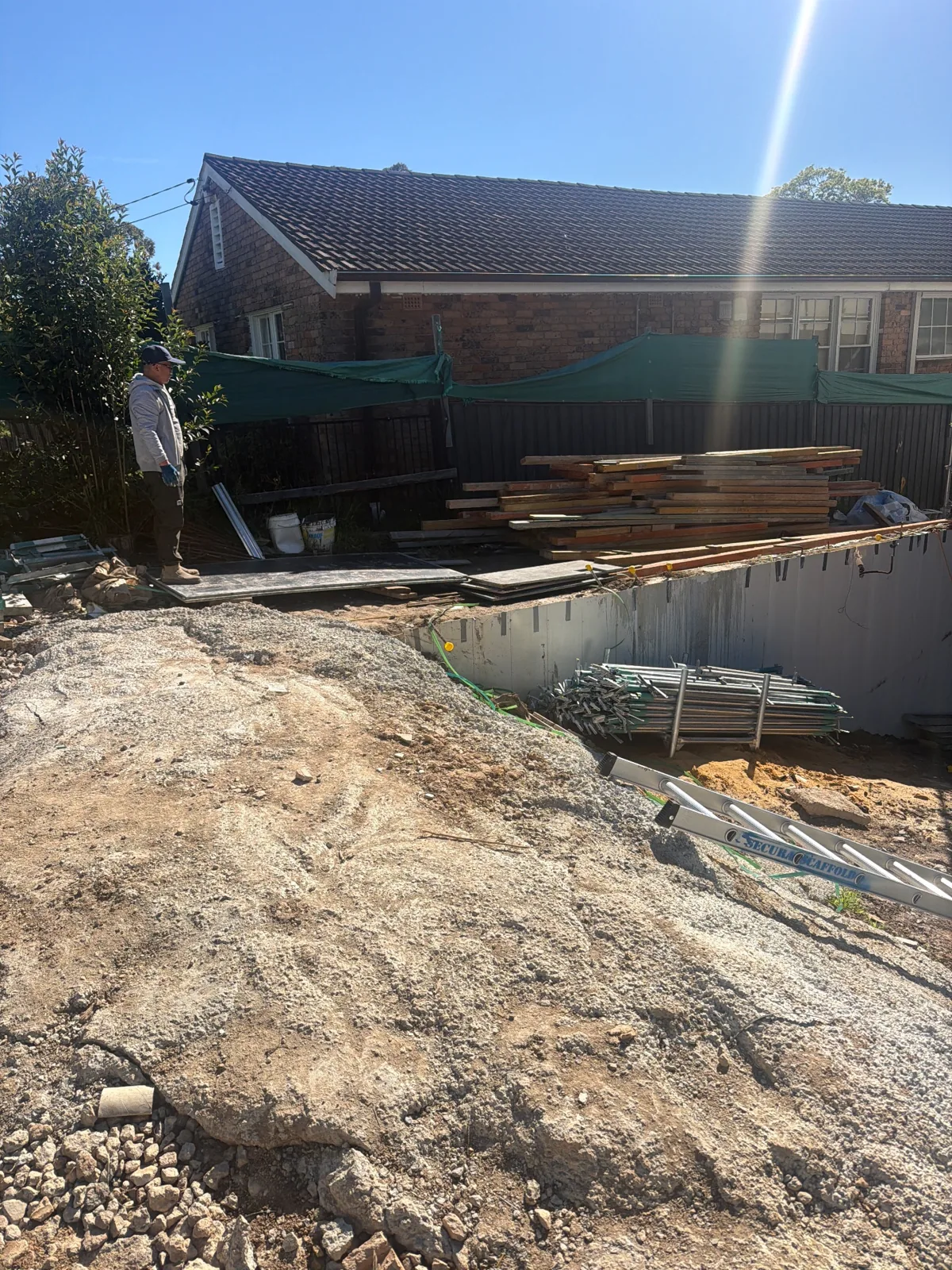

  3. The next report says roof sheets arrived and were moved in preparation for a lift, while formwork removal continued. Delivery and preparation are separate from finished roofing.

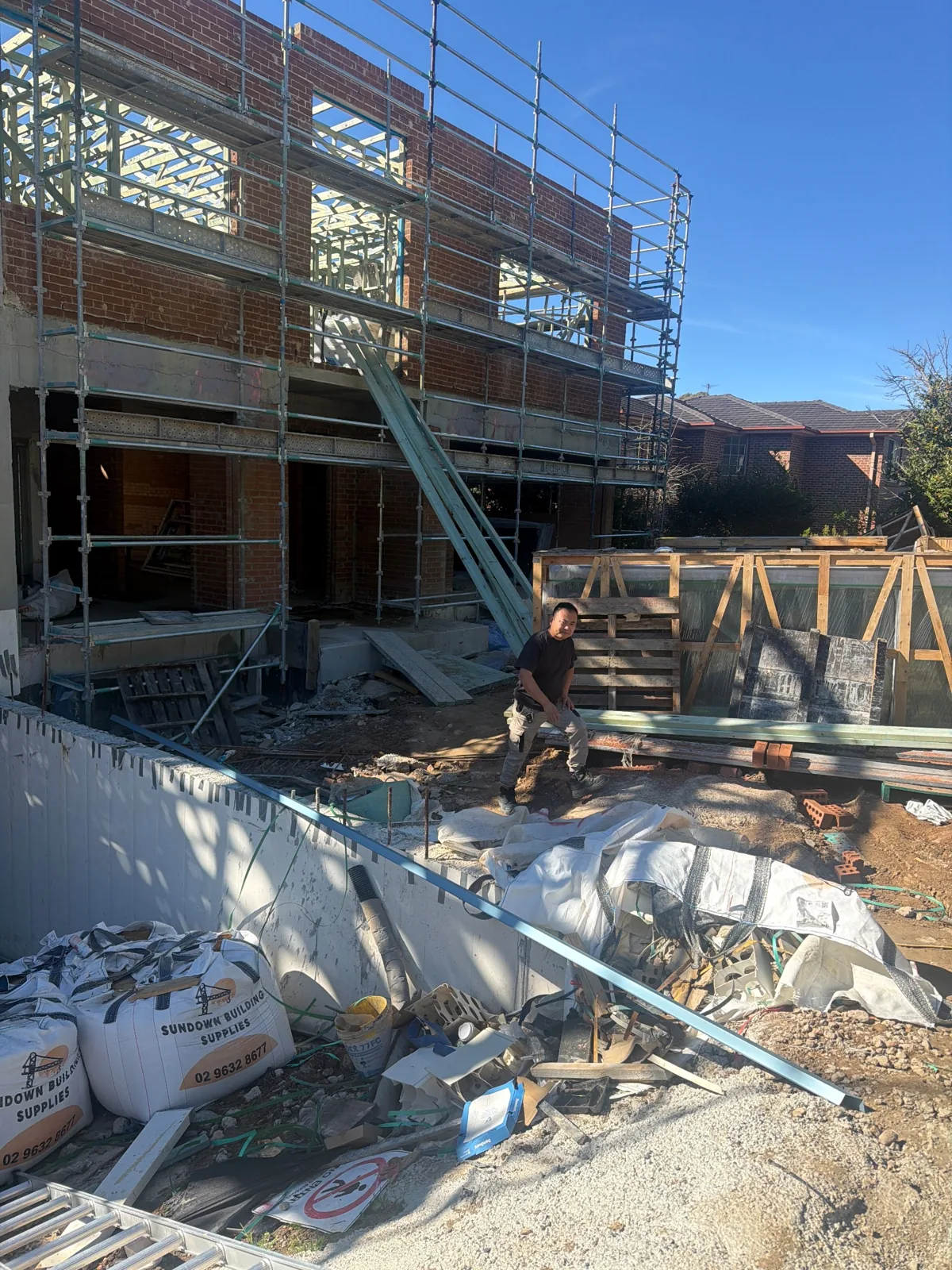

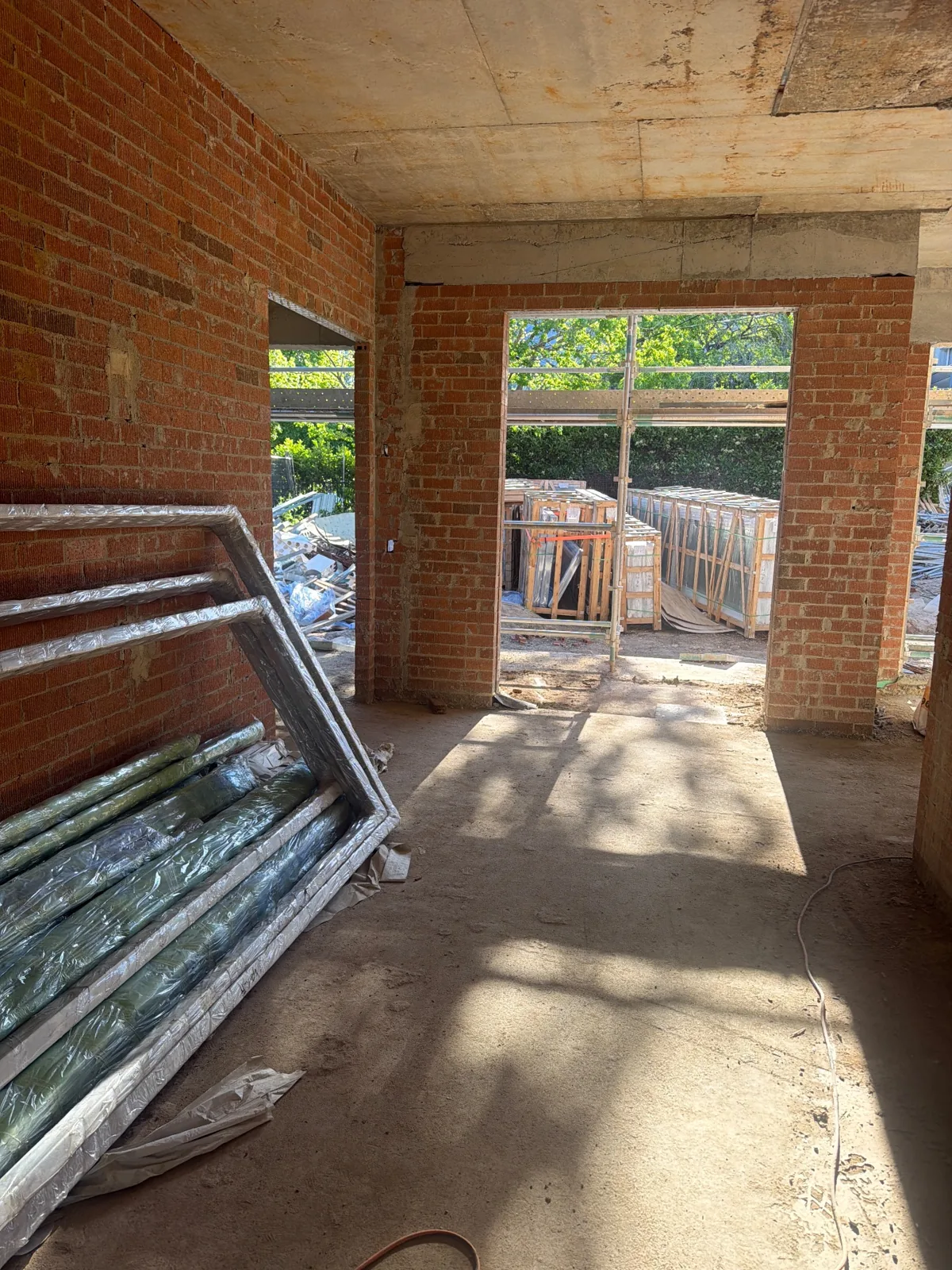

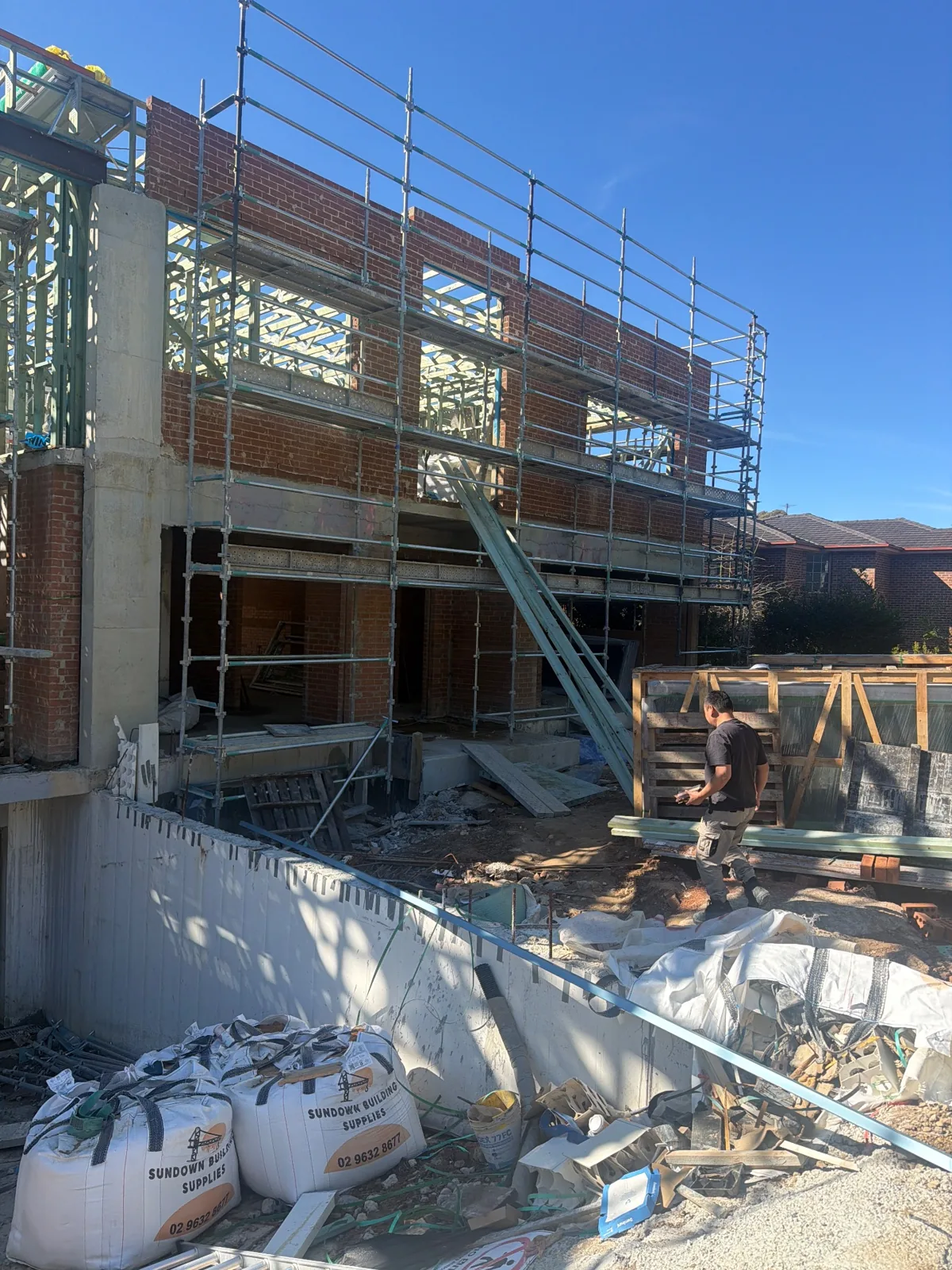

  4. Site records identify carpentry around skylights. The earlier dated photographs below show exposed masonry, framing and scaffold.

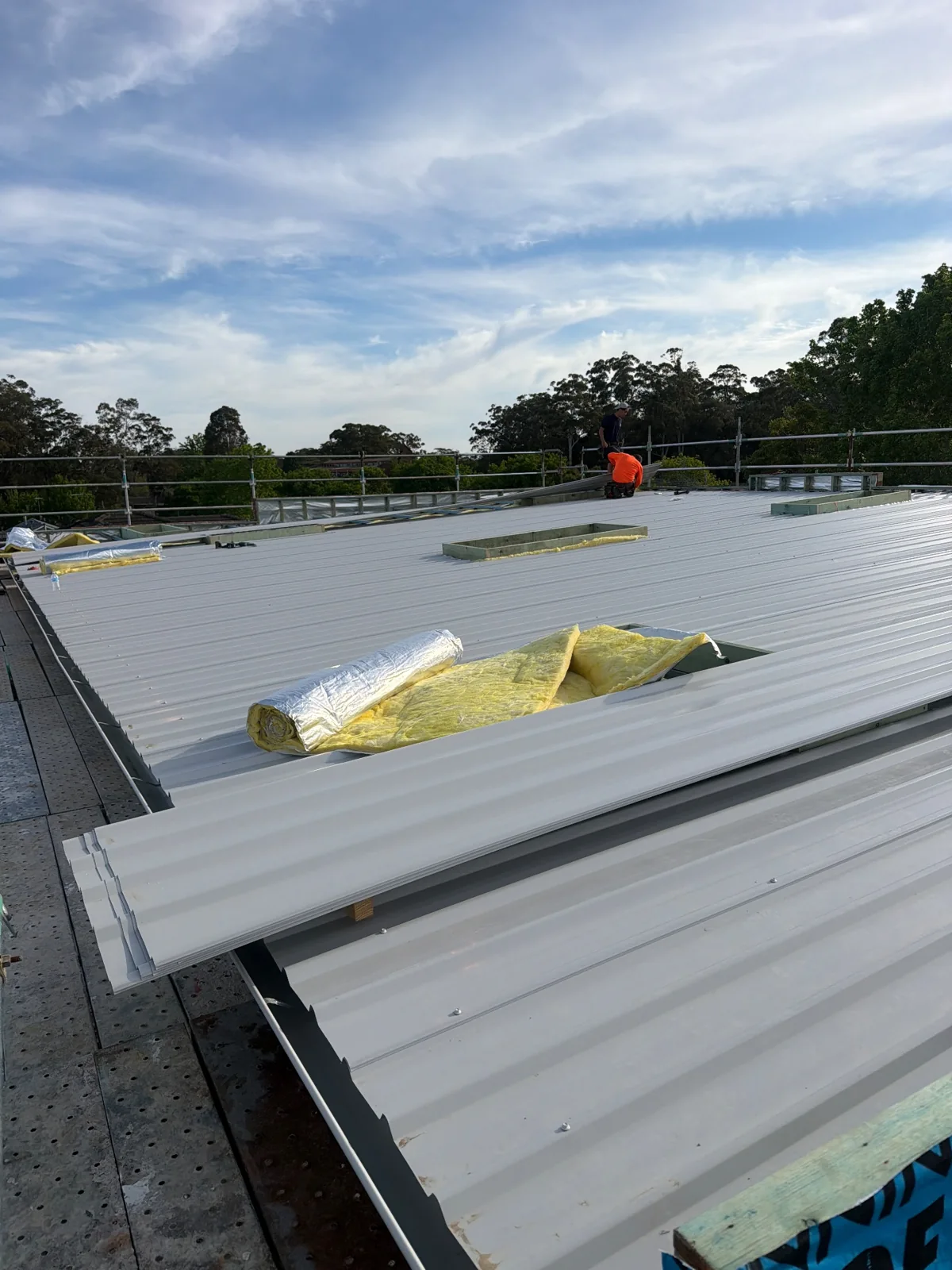

  5. The PM record places the roofer on site. Two new dated photographs show roof sheets being worked around open roof sections; they do not establish completed flashing, waterproofing or final inspection.

AUD role and checks: The project master lists the AUD operating company in its Builder field. QDE report IR06 identified pier/footing and reinforcement requirements for an extended ground-floor slab; IR07 addresses Dincel wall reinforcement. A separate certifier inspection IR01 marked the first-floor slab satisfactory subject to supporting documents. These reports concern different components and dates; IR01 does not close every IR06 or IR07 requirement.

Still to document: roof and skylight completion, their inspection and weather-tightness evidence, supporting documents requested in IR01, and item-by-item close-out for IR06–IR07. The house remains under construction.

Photographs from the site

Dates come from the linked PM site record. Photographs show visible work and do not independently certify concealed work or inspection outcomes. Public images have EXIF/GPS metadata removed; originals and hashes are retained in the dossier.

Professional inspection report index

IR01 · 2026-07-21

CDC 12425/01

Exclusive Certifiers Pty Ltd
First floor slab / Footings and Slabs · 1 original pages

The first-floor slab inspection was satisfactory subject to supporting documents; a structural compliance certificate was required.

Original identification and review scope

PCA inspection-CDC 12425 - BIR First floor slab-10 College Cres.pdf

SHA-256 29548d1cad0b32526a0ce5eca32932c15e2c4c7b6fc99805dc3b72aa86e44da0

Original-page content reviewed; issuer authenticity and digital signatures were not independently authenticated. This public page provides the source index and summary; complete reports are retained in the dossier.

IR06 · 2026-04-30

SVR26013.04A

QDE Engineering Pty Ltd
SLAB ON EXTENDING GROUND FLOOR · 3 original pages

The extended ground-floor slab report recorded pier and footing requirements, Dincel dowels and reinforcement at cut areas.

Original identification and review scope

SVR26013.04A 10 College Cres St Ives NSW 30_04_2026.pdf

SHA-256 ea57d1a6f92bdc8746281aa9092557796497341d34c232bca8daf2310d46588c

Original-page content reviewed; issuer authenticity and digital signatures were not independently authenticated. This public page provides the source index and summary; complete reports are retained in the dossier.

IR07 · 2026-05-08

SVR26013.05A

QDE Engineering Pty Ltd
DINCEL WALL · 3 original pages

Dincel wall requirements covered vertical reinforcement and hooks at corners and intersections.

Original identification and review scope

SVR26013.05A 10 College Cres St Ives NSW 08_05_2026.pdf

SHA-256 980a42480734fb9cdf0f53e664cbe7486b4768c5f63306cef36da809df252e89

Original-page content reviewed; issuer authenticity and digital signatures were not independently authenticated. This public page provides the source index and summary; complete reports are retained in the dossier.

QDE reports apply to the specified components and inspection dates, with separate exclusions for ground conditions, formwork/support and specified anchoring, plus clean-out and cover conditions. Each original remains the complete technical reference.

Rectification and stage acceptance records

Management confirmed on 29 September 2026 that rectification and acceptance of completed work stages were complete. The original report requirements are retained. Matching rectification photographs, sign-off dates and professional reinspection/clearance originals still need to be archived item by item. This is not whole-home completion; a different-stage report does not close the earlier finding.

Sources and next steps

This page uses a read-only PM snapshot, the project master/construction task tables reviewed on 30 September 2026, and user-supplied inspection originals whose pages were reviewed. Management records and professional reports are identified separately; photographs were checked for project linkage and visible content.

Next: pair each work stage with its check, before/after rectification photographs and sign-off documents, then add stage-acceptance and whole-home handover records as obtained.

Explore all 11 project dossiers · Public evidence index

Bring your plans into the discussion

Choosing a custom-home or knockdown-rebuild builder? Share the site, drawings, approval status and material specification to discuss roles, work stages, quote inclusions and available site visits.

Discuss your build

Explore custom home construction · Compare builders on the same criteria

PM work schedules and site progress

Read-only extract on 1 October 2026. The table shows stored status, planned dates, actual-finish fields and the last sync date. Some imports predate the site diaries and are historical schedule snapshots. Status and actual-finish fields can differ; blanks remain blank. Planned dates do not establish completed construction or acceptance. Newer master records, professional inspections and signed close-outs are checked separately.

Recent site-record summaries

  1. — The daily record reports the roofer on site.
  2. — Two daily records report carpentry and site assistance.
Open 23 stored PM schedule records, including older imports
Original task titleStored statusPlanned startPlanned finishActual-finish fieldLast sync
房屋拆除Recorded complete2025-08-022025-08-262025-08-262026-10-01
施工准备与土方开挖Recorded complete2025-09-142025-10-062025-10-062026-10-01
地下室框架Recorded complete after planned date2025-10-072026-02-192026-03-082026-10-01
泳池Recorded complete after planned date2026-03-182026-03-272026-03-292026-10-01
土方回填Recorded complete2026-03-282026-04-112026-04-012026-10-01
一楼拓展楼板浇水泥Recorded complete after planned date2026-03-302026-05-192026-06-112026-10-01
一楼楼板砌砖Recorded complete2026-06-182026-06-292026-06-242026-10-01
二楼楼面模板钢筋浇水泥Recorded complete after planned date2026-06-282026-07-142026-07-222026-10-01
二楼木架(水泥强度养护)Recorded complete after planned date2026-07-262026-08-062026-08-112026-10-01
二楼砌砖+dincel水泥墙体Recorded complete after planned date2026-08-302026-09-052026-09-132026-10-01
屋顶Recorded overdue2026-09-012026-09-20—2026-10-01
gyprock(天花、墙、抹灰及修饰)In progress2026-09-232026-11-04—2026-10-01
Render wall 外墙粉刷In progress2026-09-242026-11-09—2026-10-01
门窗安装In progress2026-09-302026-10-10—2026-10-01
All service roughing in Air, Water, Power, Air Con 水电煤等排线Not started2026-10-022026-10-12—2026-10-01
室外园林(园建、绿化)Not started2026-11-032026-11-26—2026-10-01
室内乳胶漆Not started2026-11-052026-11-25—2026-10-01
室内防水及瓷砖Not started2026-11-052026-12-22—2026-10-01
室内地板Not started2026-11-262026-12-13—2026-10-01
楼梯/阳台拦杆、扶手Not started2026-12-022026-12-13—2026-10-01
柜体、卫浴、灯具安装Not started2026-12-052027-01-20—2026-10-01
OC验收Not started2027-01-242027-02-14—2026-10-01
OC以外场地装修Not started2027-02-152027-03-31—2026-10-01

Request a site visit and document review — Subject to owner consent, site safety, work in progress and a confirmed time; a request is not a confirmed appointment.
