20 Albert Street, Gladesville · Construction progress and project evidence

Site preparation and monitoring

20 Albert Street, Gladesville, NSW 2111, Australia
Reviewed: 1 October 2026 AEST · Stages reflect their dated source records

Recorded workSite preparation and monitoring
Published site photos8
Original report indexPending

Project rolesProgressSite photosInspectionsRectification

Project roles and responsibility

The project master reviewed on 30 September 2026 names Opera Ridge Projects Pty Ltd in the Builder field. This page presents project coordination, stage records and document management within the AUD operating framework. The master field is a project record; the contract, licence and appointment documents determine construction responsibility.

Projects use their respective responsible entities. The shared management system shows operating coordination; corporate relationships and responsibility are checked against the relevant documents.

Dated construction progress

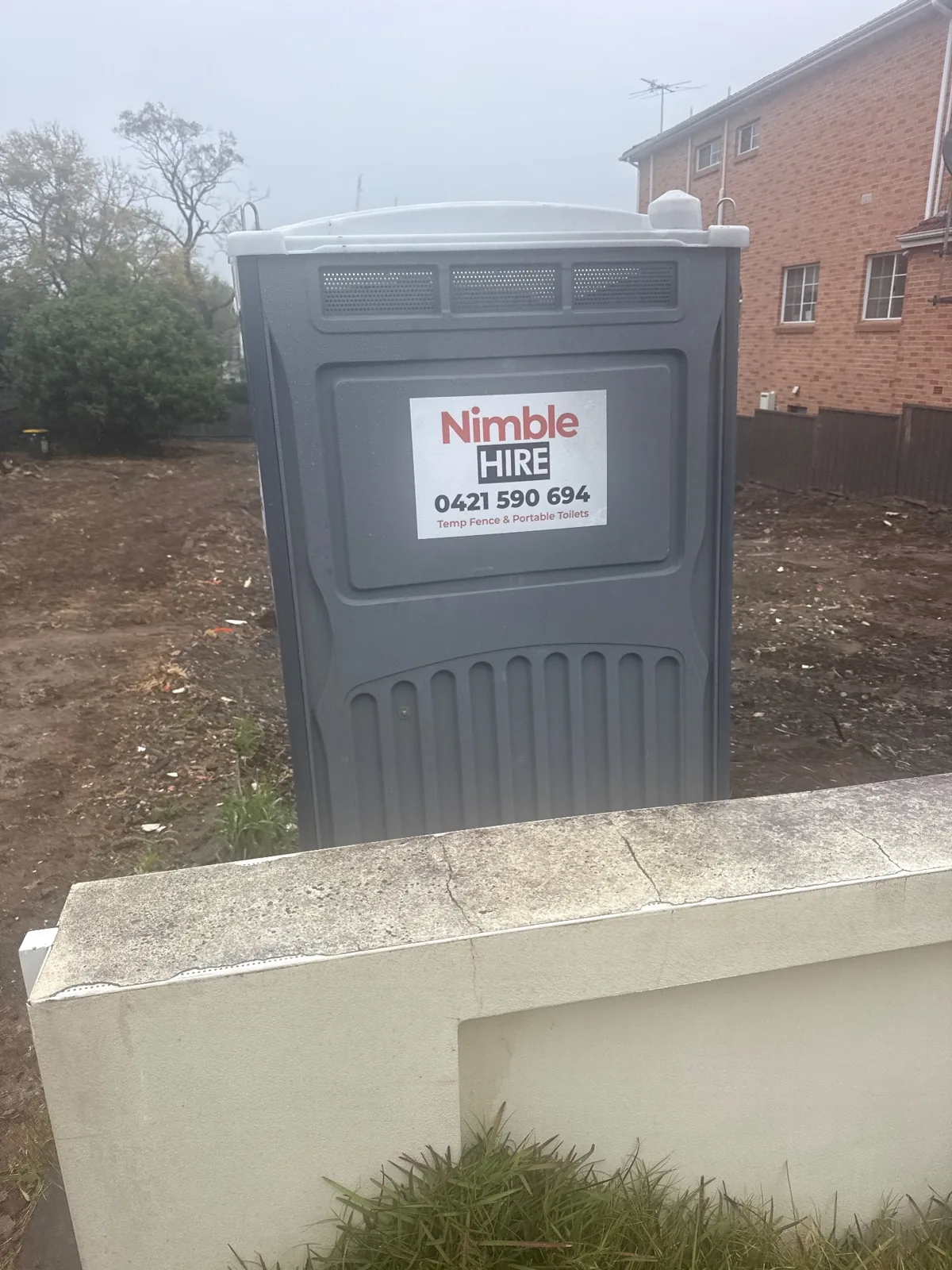

  1. Temporary toilet delivery recorded.

  2. Site monitoring and attendance recorded.

  3. Continued site attendance; photographs show fencing, a cleared site and temporary facilities.

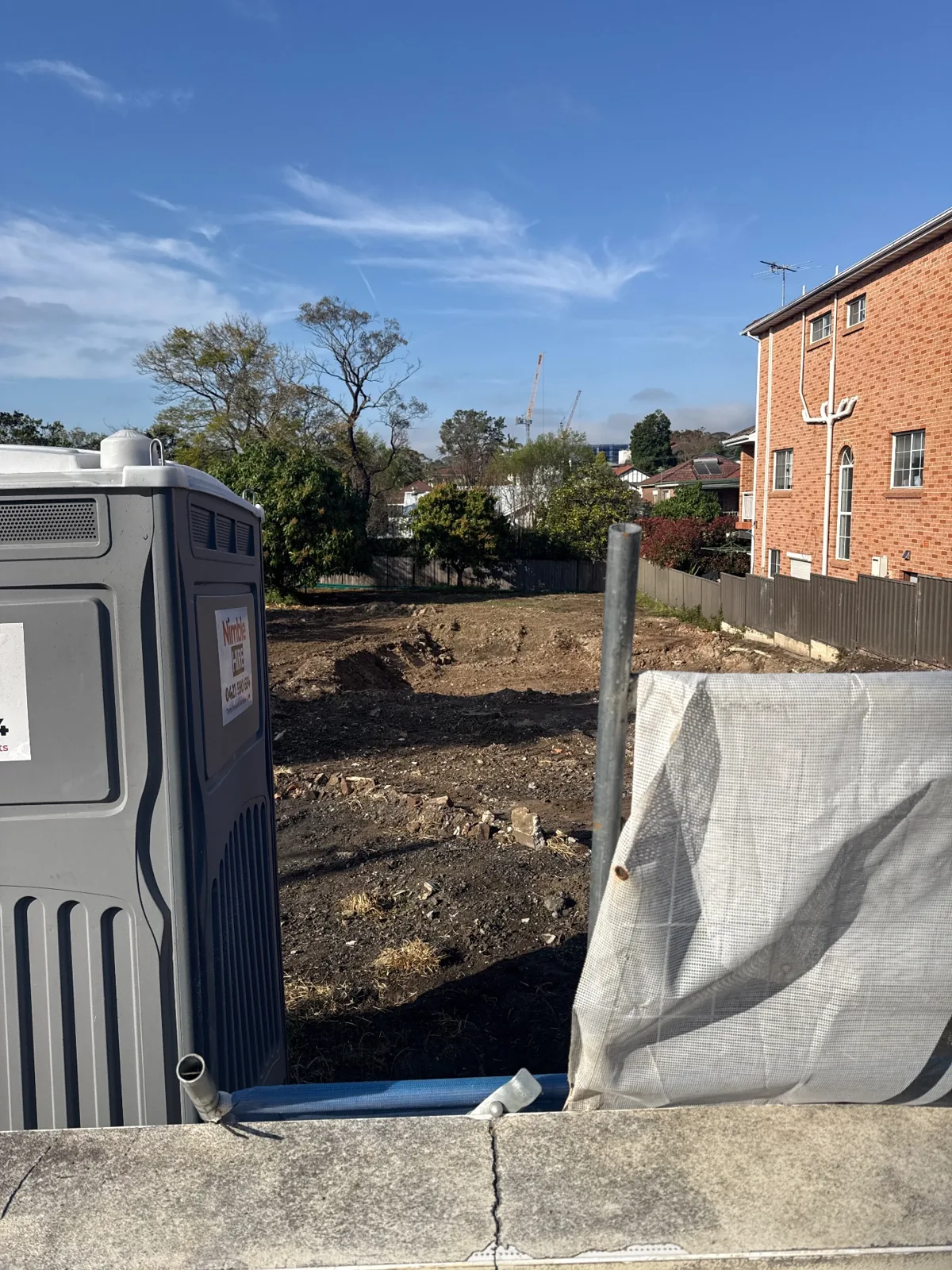

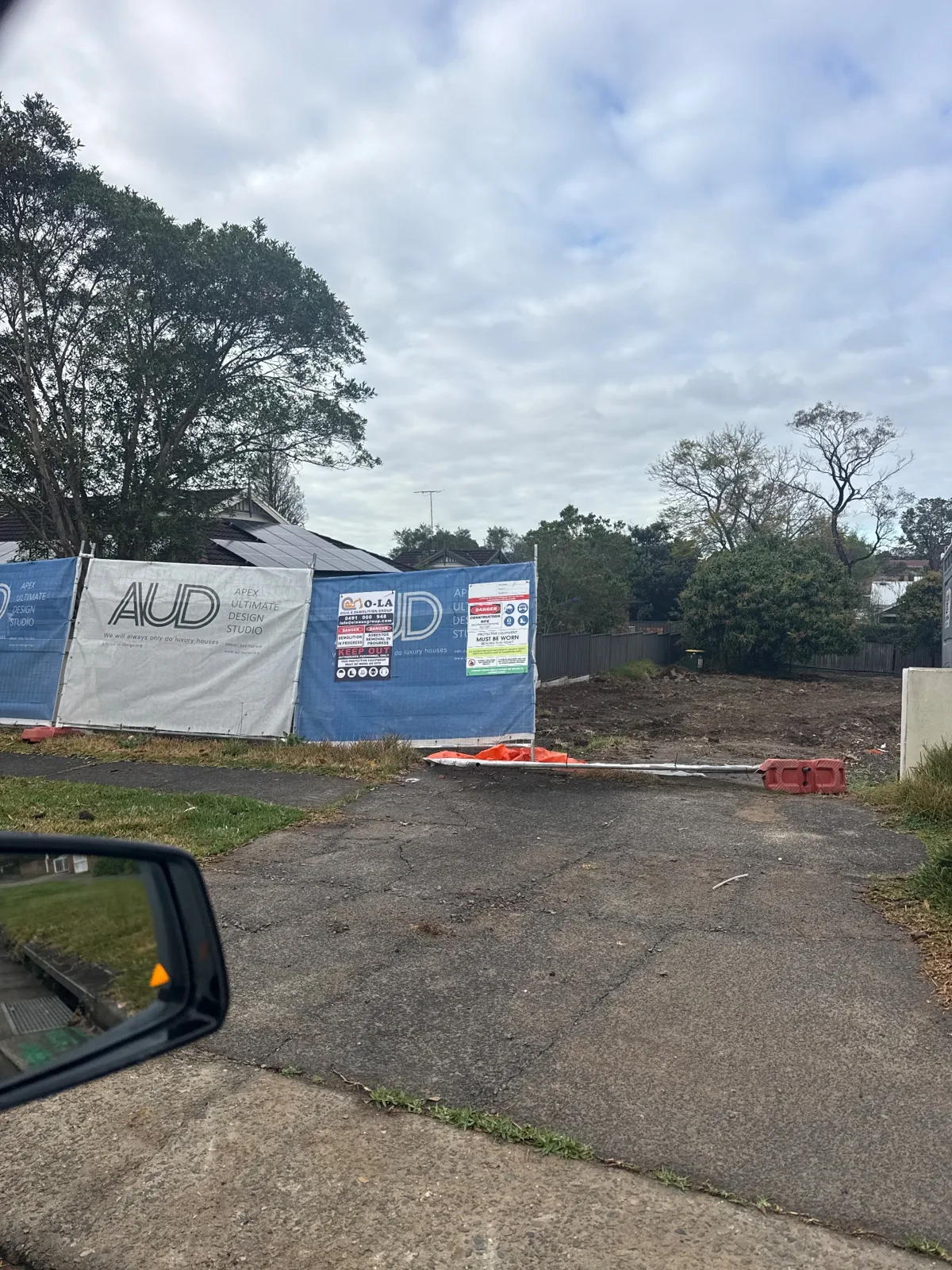

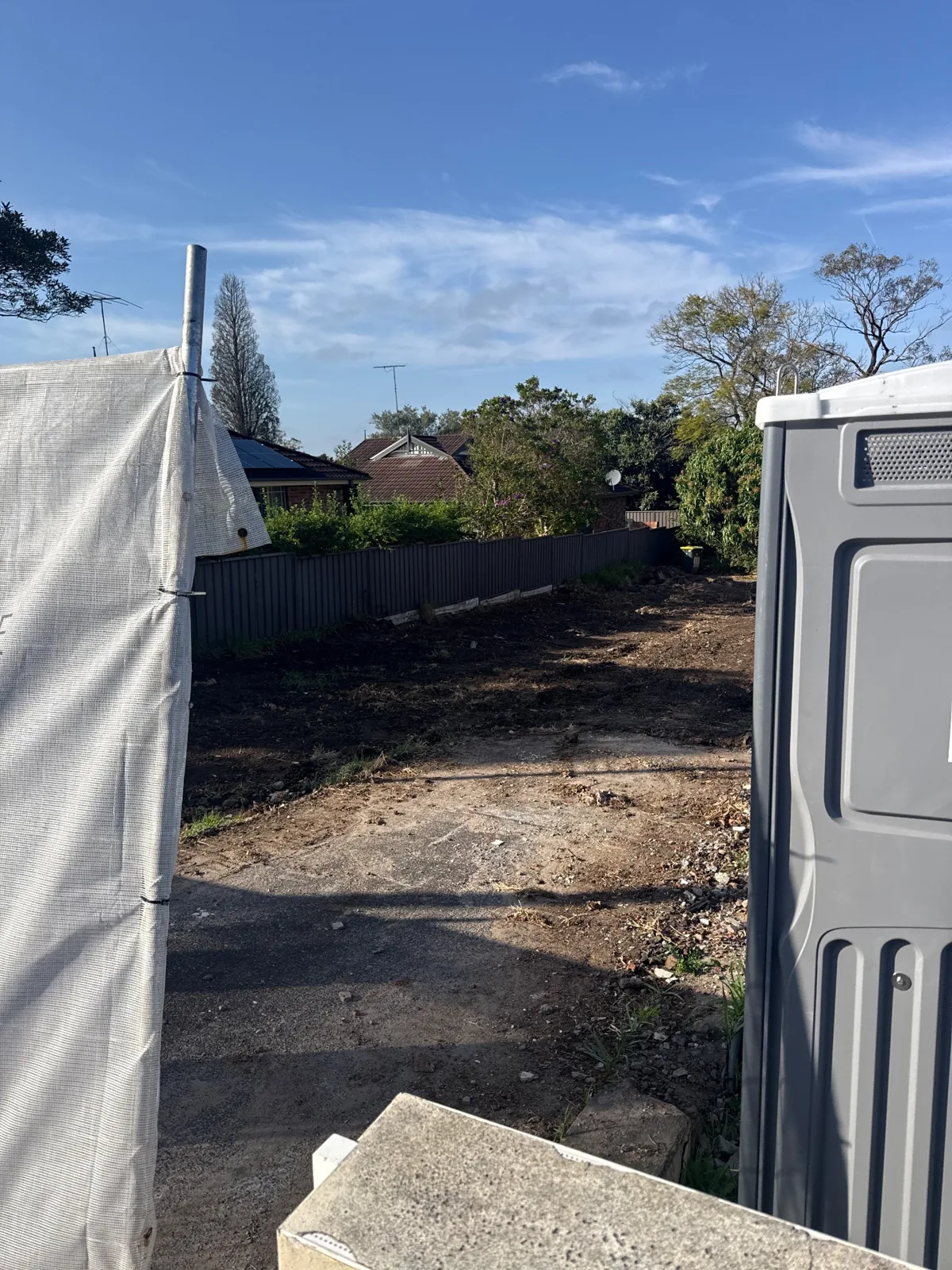

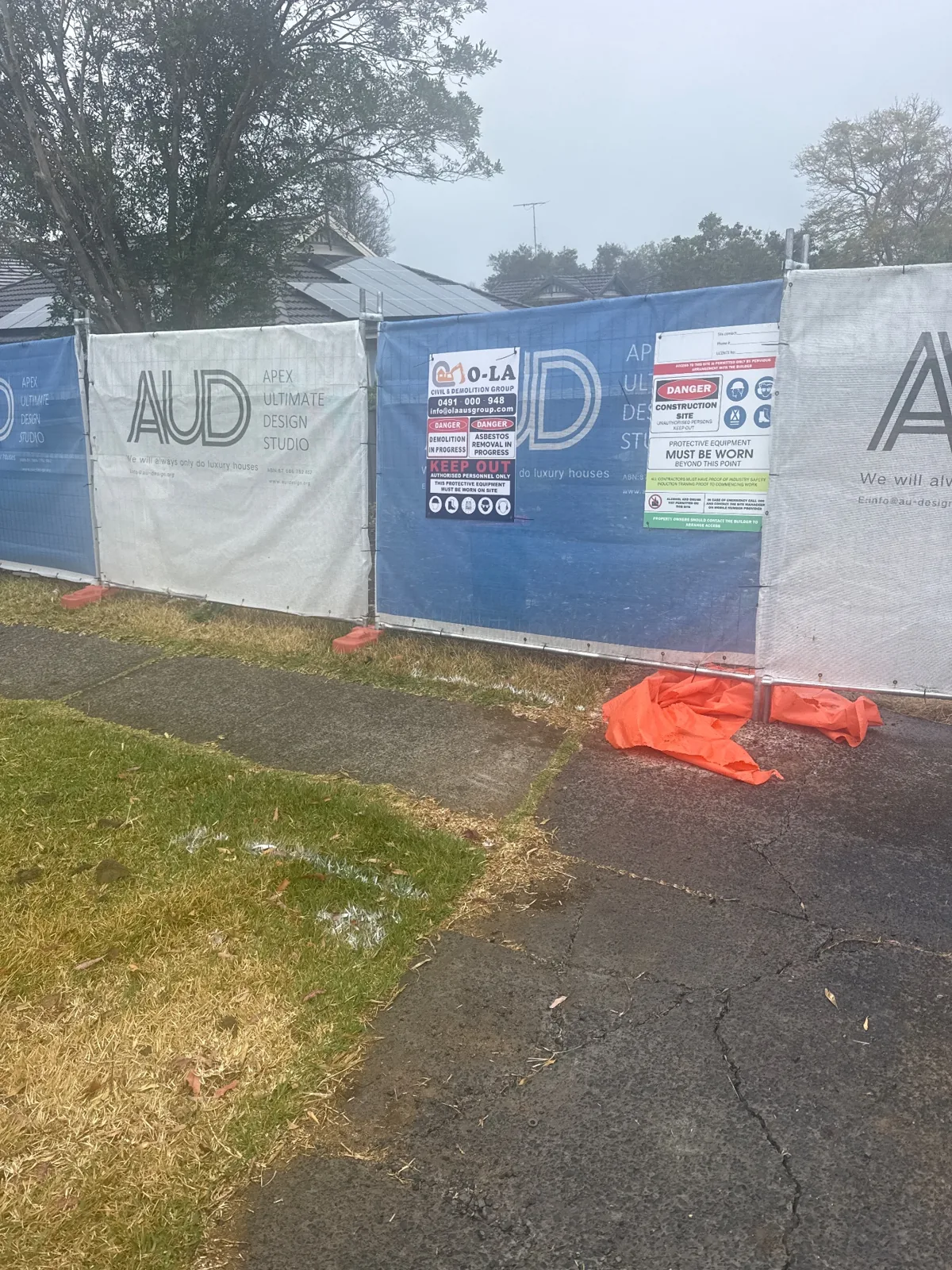

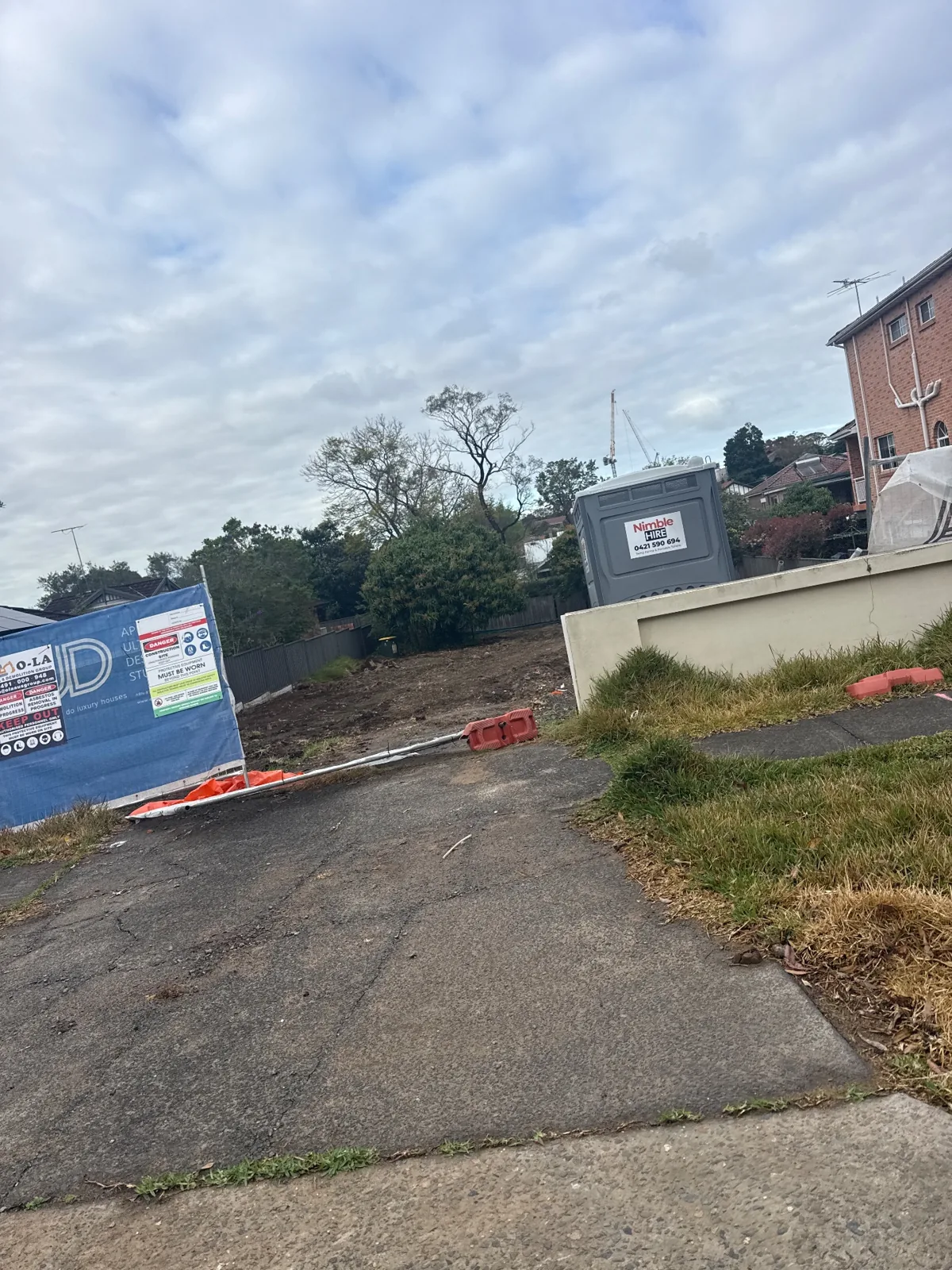

Photographs from the site

Dates come from the linked PM site record. Photographs show visible work and do not independently certify concealed work or inspection outcomes. Public images have EXIF/GPS metadata removed; originals and hashes are retained in the dossier.

Professional inspection report index

No original professional inspection report for this address is currently in this page’s dossier. Site progress, demolition tasks and scheme meetings are not professional acceptance findings.

Rectification and stage acceptance records

Management has confirmed stage acceptance and related rectification for completed work. This page does not yet have matching professional check/reinspection originals; progress photographs do not establish professional clearance.

Sources and next steps

This page uses a read-only PM snapshot, the project master/construction task tables reviewed on 30 September 2026, and user-supplied inspection originals whose pages were reviewed. Management records and professional reports are identified separately; photographs were checked for project linkage and visible content.

Next: pair each work stage with its check, before/after rectification photographs and sign-off documents, then add stage-acceptance and whole-home handover records as obtained.

Explore all 11 project dossiers · Public evidence index

Bring your plans into the discussion

Choosing a custom-home or knockdown-rebuild builder? Share the site, drawings, approval status and material specification to discuss roles, work stages, quote inclusions and available site visits.

Discuss your build

Explore custom home construction · Knockdown rebuild scope and process · Compare builders on the same criteria

PM work schedules and site progress

Read-only extract on 1 October 2026. The table shows stored status, planned dates, actual-finish fields and the last sync date. Some imports predate the site diaries and are historical schedule snapshots. Status and actual-finish fields can differ; blanks remain blank. Planned dates do not establish completed construction or acceptance. Newer master records, professional inspections and signed close-outs are checked separately.

Recent site-record summaries

  1. — Site staff report the fence is in order; no independent sign-off accompanies the statement.
  2. — The daily record reports site care.
Open 14 stored PM schedule records, including older imports
Original task titleStored statusPlanned startPlanned finishActual-finish fieldLast sync
OSD和WRT施工Planned———2026-07-30
一楼拓展楼板浇筑Planned———2026-07-30
一楼楼板砌砖Planned———2026-07-30
二楼木架(水泥强度养护)Planned———2026-07-30
二楼楼面模板钢筋浇水泥Planned———2026-07-30
二楼砌砖+dincel水泥墙体Planned———2026-07-30
土方开挖Planned——2026-07-222026-07-30
地下室Dincle墙体浇筑Planned———2026-07-30
地下室底板浇筑Planned———2026-07-30
地下室顶板浇筑Planned———2026-07-30
屋顶彩钢瓦Planned———2026-07-30
开工Recorded complete—2026-07-292026-07-222026-07-30
游泳池施工Planned———2026-07-30
脚手架搭设Planned———2026-07-30
