3 Amesbury Avenue, St Ives · Construction progress and project evidence
Demolition and survey preparation
Project rolesProgressSite photosInspectionsRectification
Project roles and responsibility
The project master reviewed on 30 September 2026 names Opera Ridge Projects Pty Ltd in the Builder field. This page presents project coordination, stage records and document management within the AUD operating framework. The master field is a project record; the contract, licence and appointment documents determine construction responsibility.
Projects use their respective responsible entities. The shared management system shows operating coordination; corporate relationships and responsibility are checked against the relevant documents.
Dated construction progress

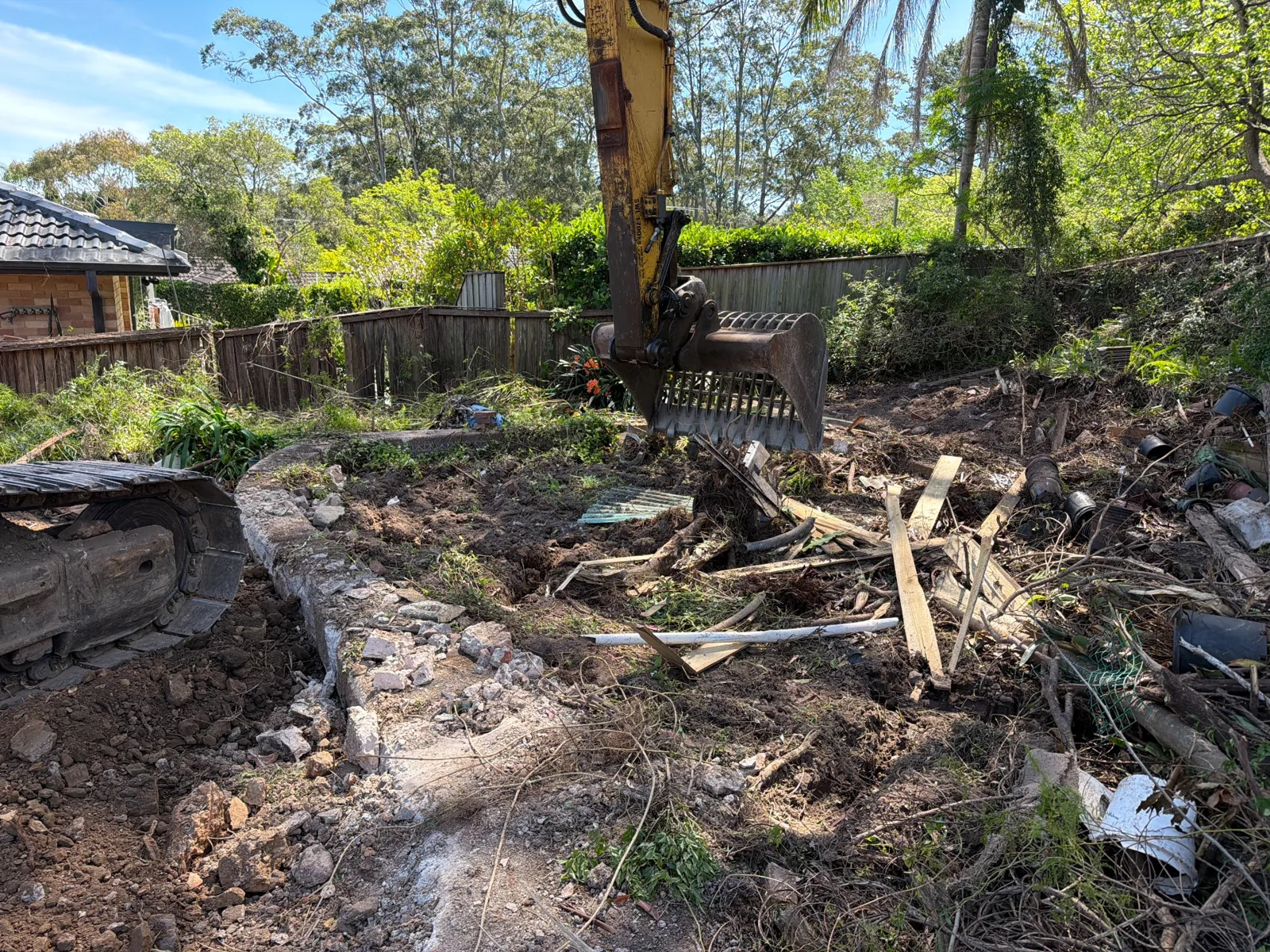

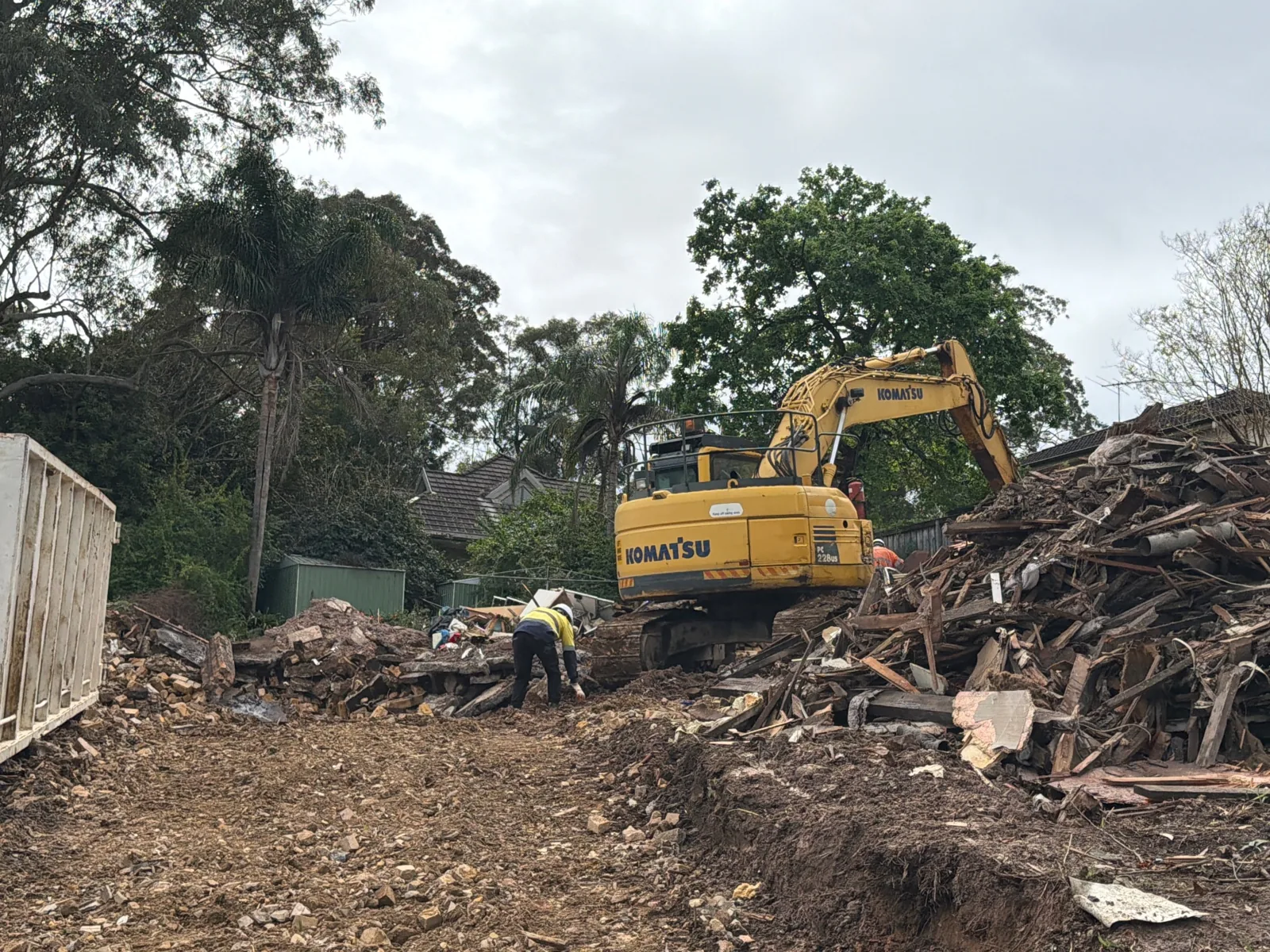

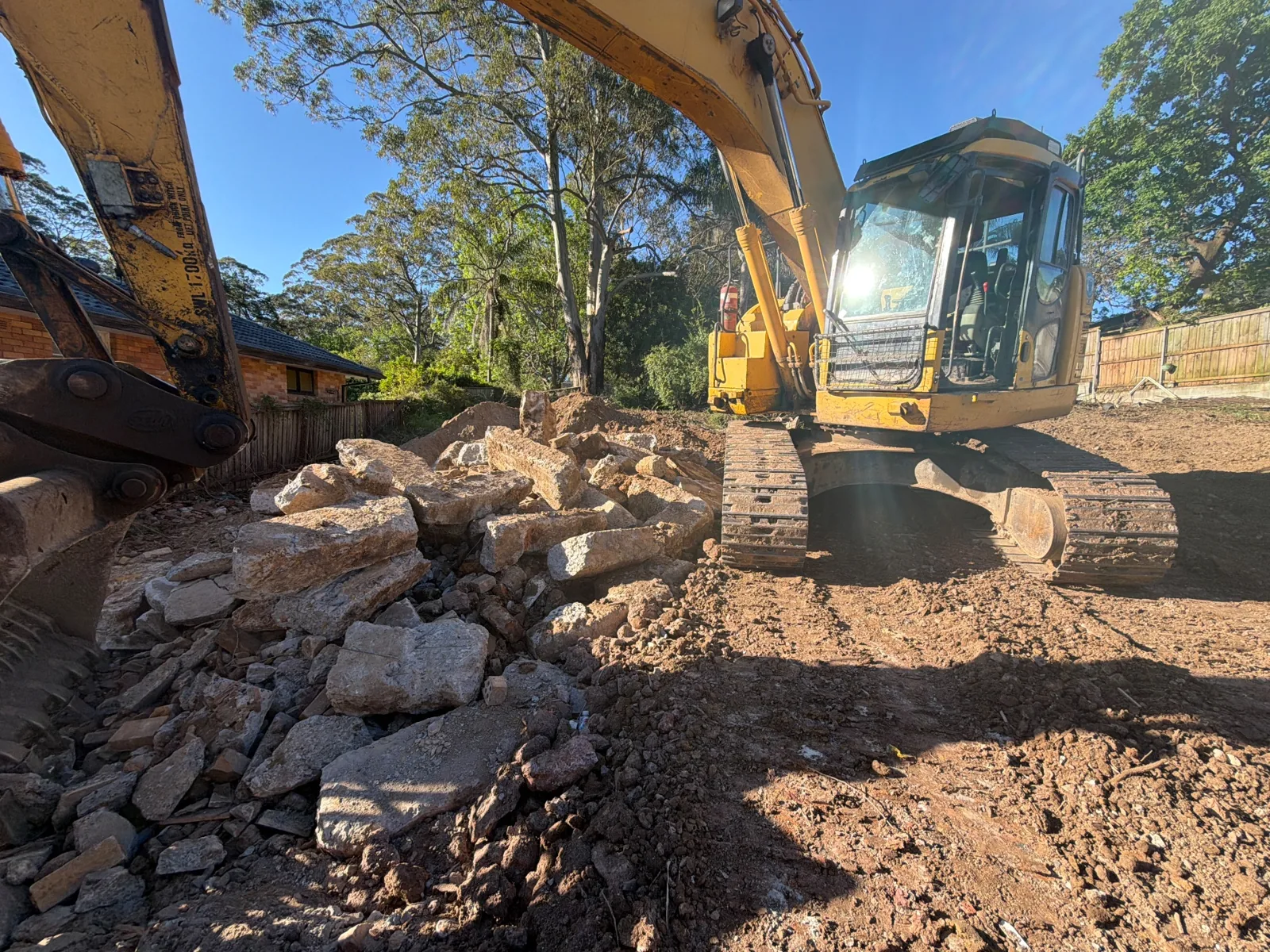

Excavator demolition work recorded.

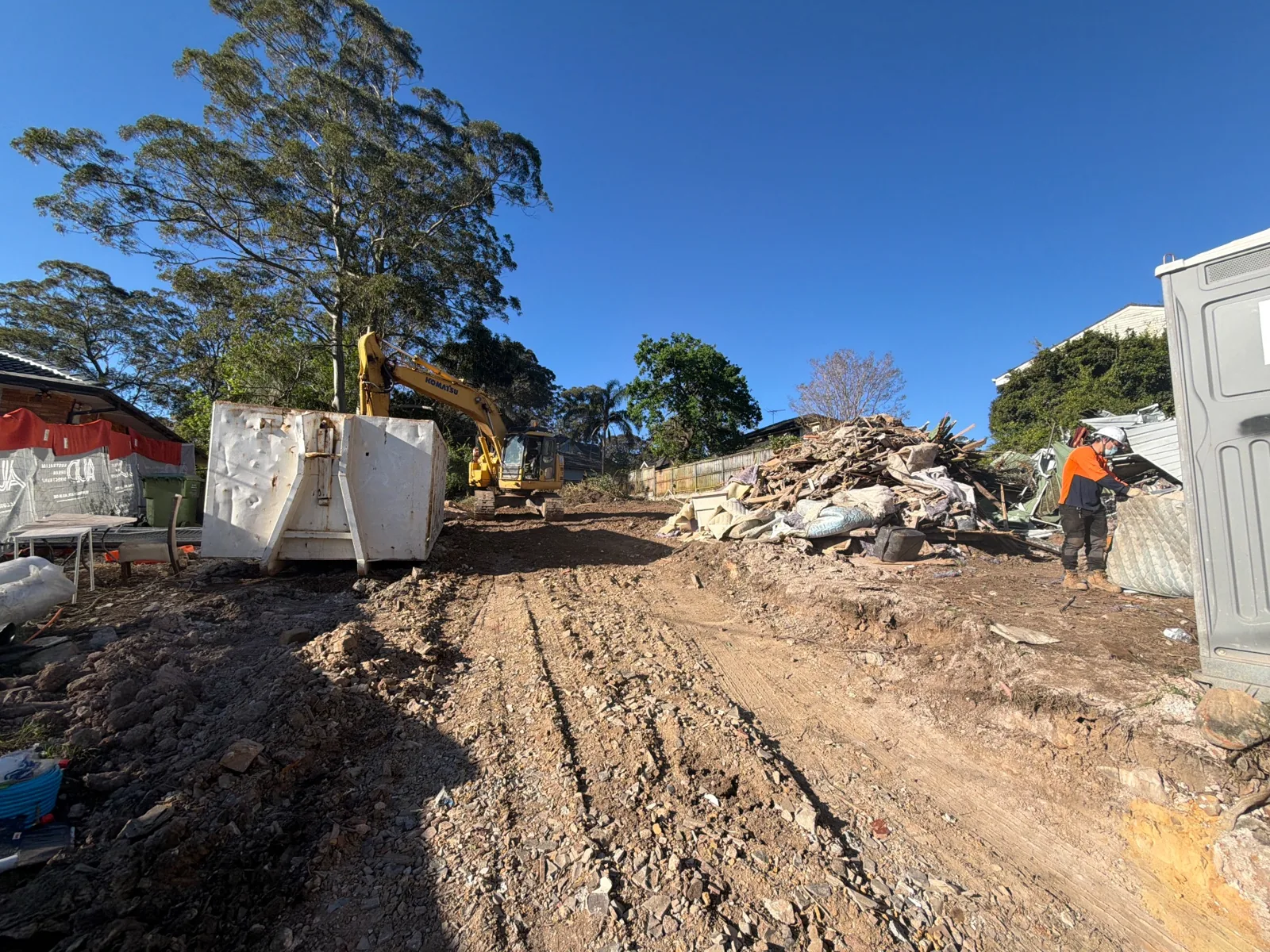

Demolition continues; the report describes plans for a survey and subsequent excavation.

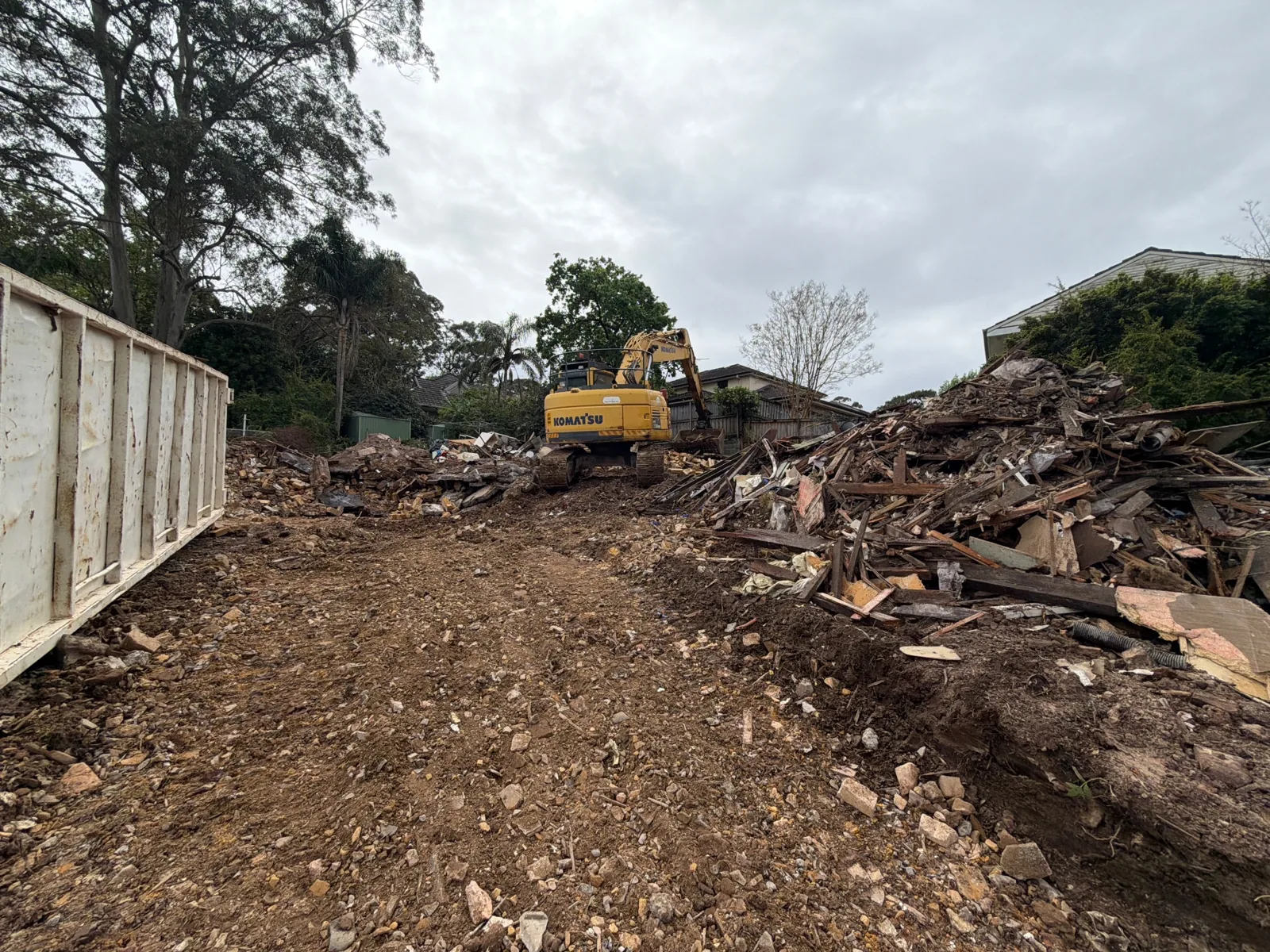

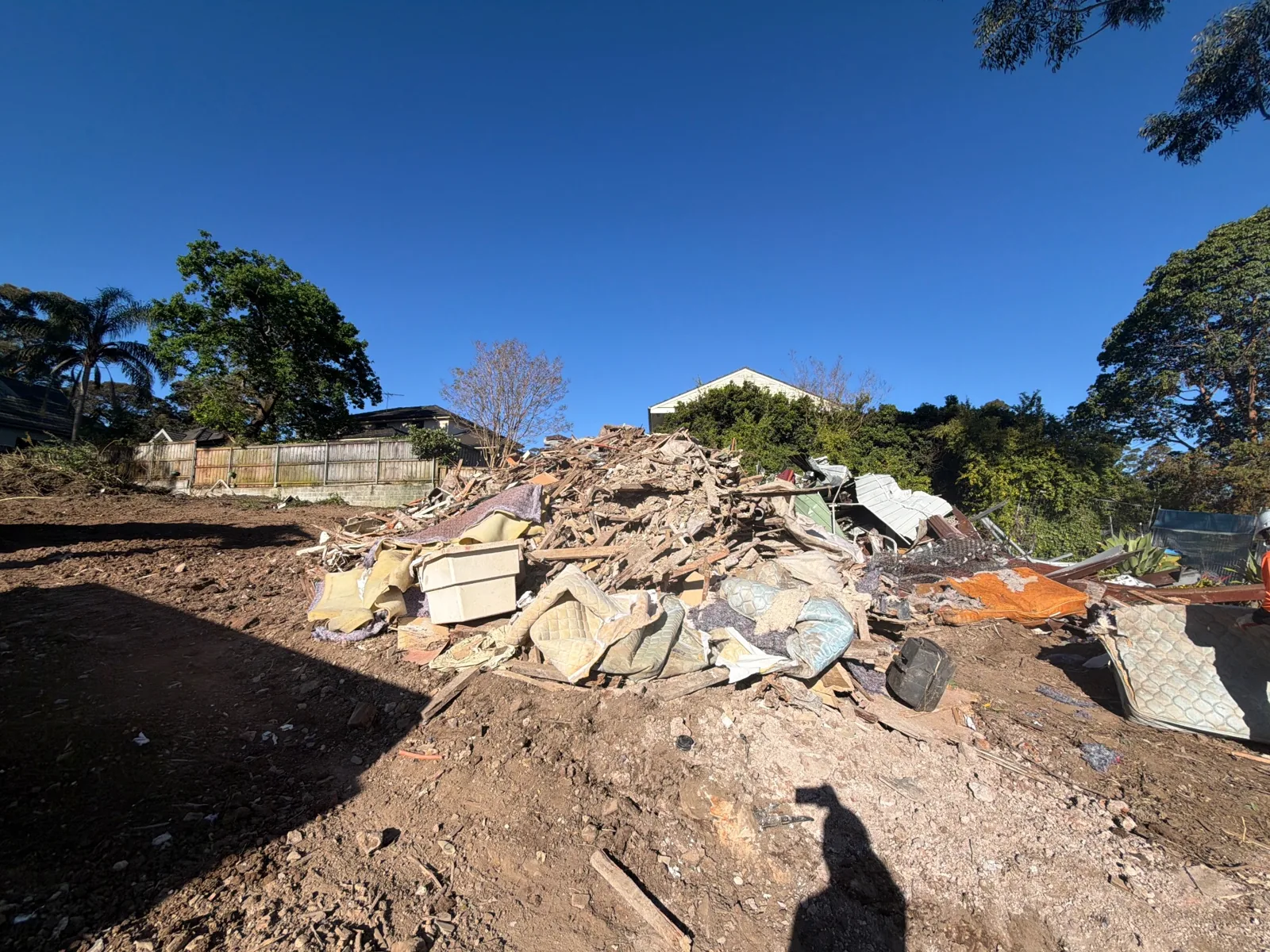

The report describes demolition as nearly complete, with former pool and foundation concrete still to break out.

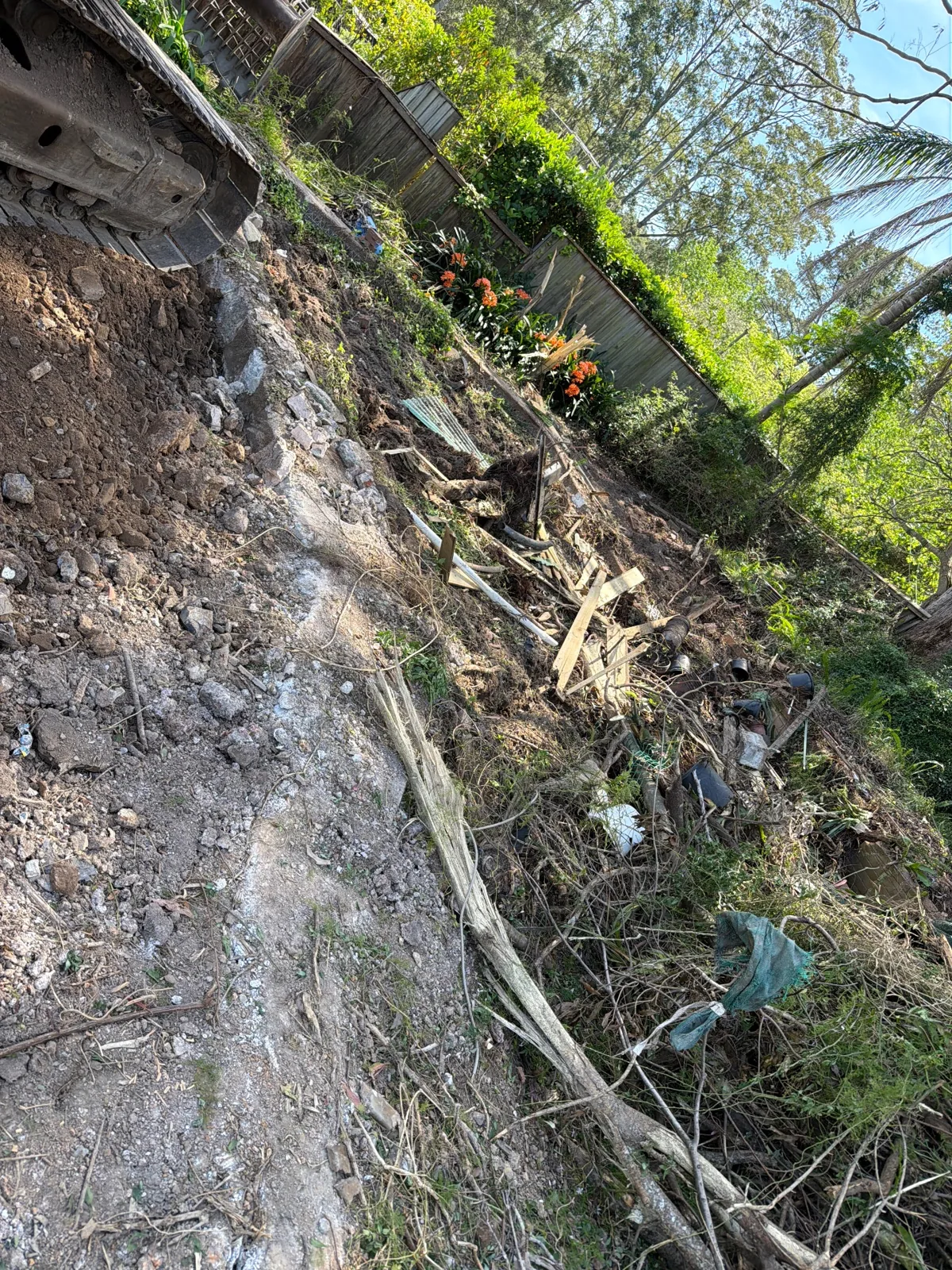

Photographs from the site








Dates come from the linked PM site record. Photographs show visible work and do not independently certify concealed work or inspection outcomes. Public images have EXIF/GPS metadata removed; originals and hashes are retained in the dossier.
Professional inspection report index
No original professional inspection report for this address is currently in this page’s dossier. Site progress, demolition tasks and scheme meetings are not professional acceptance findings.
Rectification and stage acceptance records
Management has confirmed stage acceptance and related rectification for completed work. This page does not yet have matching professional check/reinspection originals; progress photographs do not establish professional clearance.
Sources and next steps
This page uses a read-only PM snapshot, the project master/construction task tables reviewed on 30 September 2026, and user-supplied inspection originals whose pages were reviewed. Management records and professional reports are identified separately; photographs were checked for project linkage and visible content.
Next: pair each work stage with its check, before/after rectification photographs and sign-off documents, then add stage-acceptance and whole-home handover records as obtained.
Bring your plans into the discussion
Choosing a custom-home or knockdown-rebuild builder? Share the site, drawings, approval status and material specification to discuss roles, work stages, quote inclusions and available site visits.
Discuss your buildExplore custom home construction · Knockdown rebuild scope and process · Compare builders on the same criteria
PM work schedules and site progress
Read-only extract on 1 October 2026. The table shows stored status, planned dates, actual-finish fields and the last sync date. Some imports predate the site diaries and are historical schedule snapshots. Status and actual-finish fields can differ; blanks remain blank. Planned dates do not establish completed construction or acceptance. Newer master records, professional inspections and signed close-outs are checked separately.
Recent site-record summaries
- — Demolition continued; the record reports purchasing tree and boundary protection materials and discussing a pool contractor start for the following week. The pool work is planned, rather than established as started or completed.
- — The daily record reports remaining concrete from the old pool and foundations requiring demolition.
Open 15 stored PM schedule records, including older imports
| Original task title | Stored status | Planned start | Planned finish | Actual-finish field | Last sync |
|---|---|---|---|---|---|
| 拆房 | Not started | 2026-07-27 | 2026-08-19 | — | 2026-07-26 |
| 土方开挖 | Not started | 2026-08-20 | 2026-08-31 | — | 2026-07-26 |
| 地下室底板浇筑 | Not started | 2026-08-31 | 2026-09-16 | — | 2026-07-26 |
| 地下室Dincle墙体浇筑 | Not started | 2026-09-17 | 2026-10-06 | — | 2026-07-26 |
| 游泳池施工 | Not started | 2026-10-07 | 2026-10-17 | — | 2026-07-26 |
| 地下室顶板浇筑 | Not started | 2026-10-19 | 2026-11-07 | — | 2026-07-26 |
| 一楼拓展楼板浇筑 | Not started | 2026-11-10 | 2026-11-22 | — | 2026-07-26 |
| OSD和WRT施工 | Not started | 2026-11-22 | 2026-12-01 | — | 2026-07-26 |
| 一楼楼板砌砖 | Not started | 2026-12-02 | 2026-12-13 | — | 2026-07-26 |
| 脚手架搭设 | Not started | 2026-12-14 | 2026-12-16 | — | 2026-07-26 |
| 二楼楼面模板钢筋浇水泥 | Not started | 2026-12-17 | 2027-01-03 | — | 2026-07-26 |
| 二楼木架(水泥强度养护) | Not started | 2027-01-06 | 2027-01-19 | — | 2026-07-26 |
| 二楼砌砖+dincel水泥墙体 | Not started | 2027-01-20 | 2027-01-27 | — | 2026-07-26 |
| 屋顶彩钢瓦 | Not started | 2027-01-28 | 2027-02-16 | — | 2026-07-26 |
| 开工 | In progress | — | 2026-07-27 | — | 2026-07-26 |
Request a site visit and document review — Subject to owner consent, site safety, work in progress and a confirmed time; a request is not a confirmed appointment.
