Sydney residential projects · Dated site records

9 Barons Crescent, Hunters Hill · Construction progress and project evidence

Demolition and site-access coordination

9 Barons Crescent, Hunters Hill, NSW 2110, Australia
Reviewed: 1 October 2026 AEST · Stages reflect their dated source records

Recorded workDemolition and site-access coordination
Published site photos8
Original report indexPending

Project rolesProgressSite photosInspectionsRectification

Project roles and responsibility

The AUD operating framework coordinates the project progress and documents shown here. The reviewed project master has no Builder value; the contracting builder is not established in this dossier.

Projects use their respective responsible entities. The shared management system shows operating coordination; corporate relationships and responsibility are checked against the relevant documents.

Dated construction progress

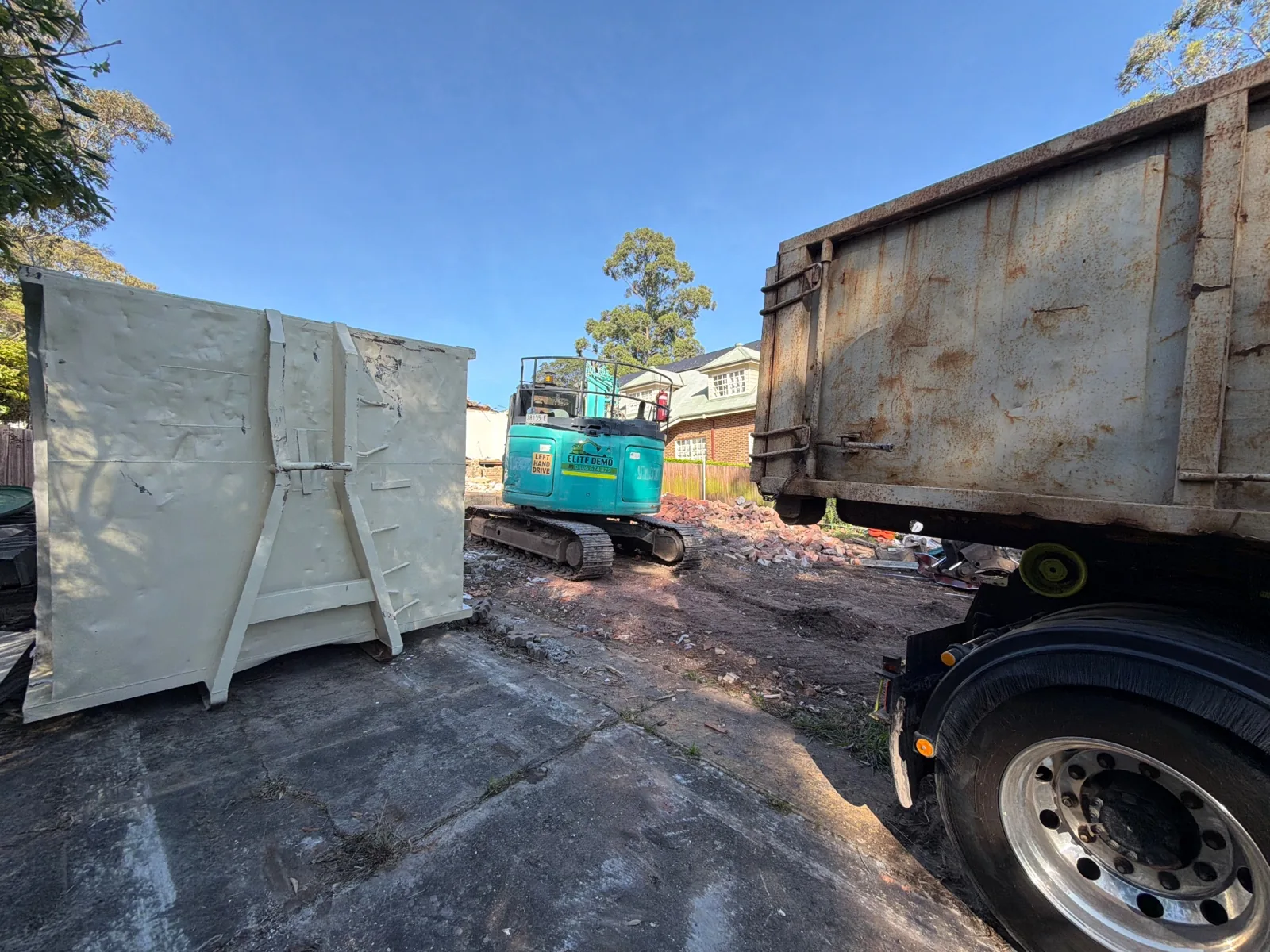

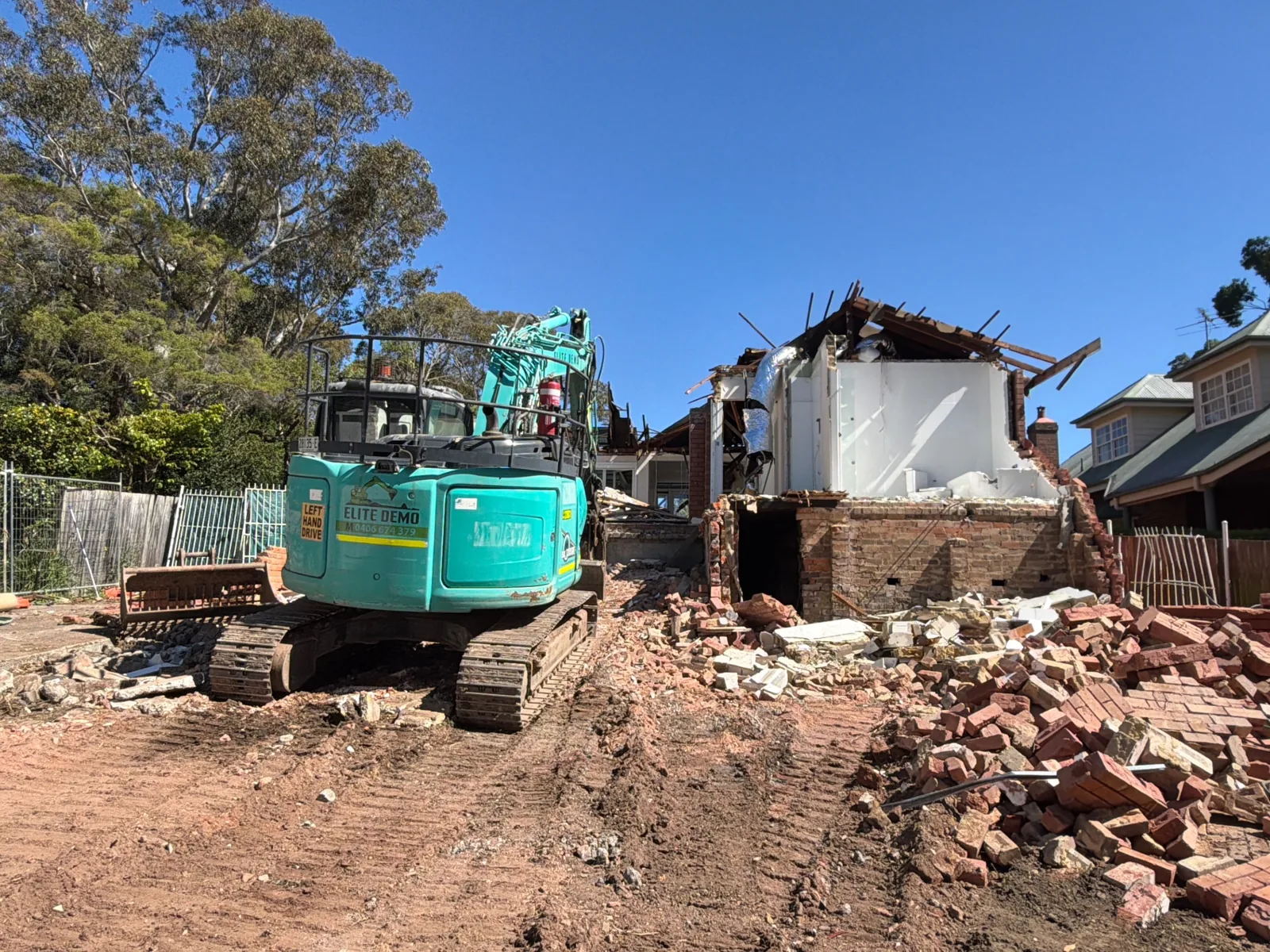

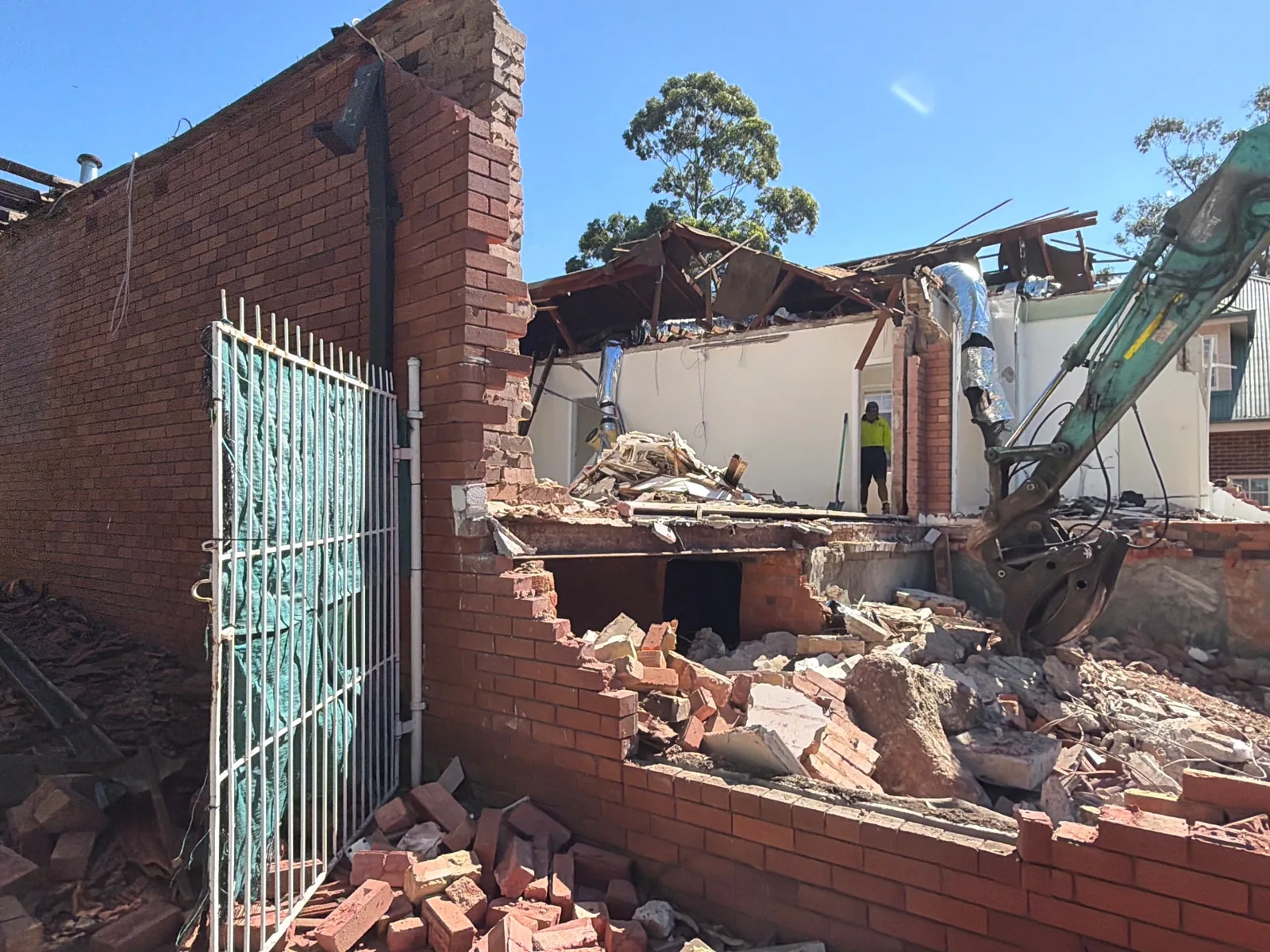

  1. Demolition and power-box installation recorded; a broken-down truck obstructed the entrance and material removal.

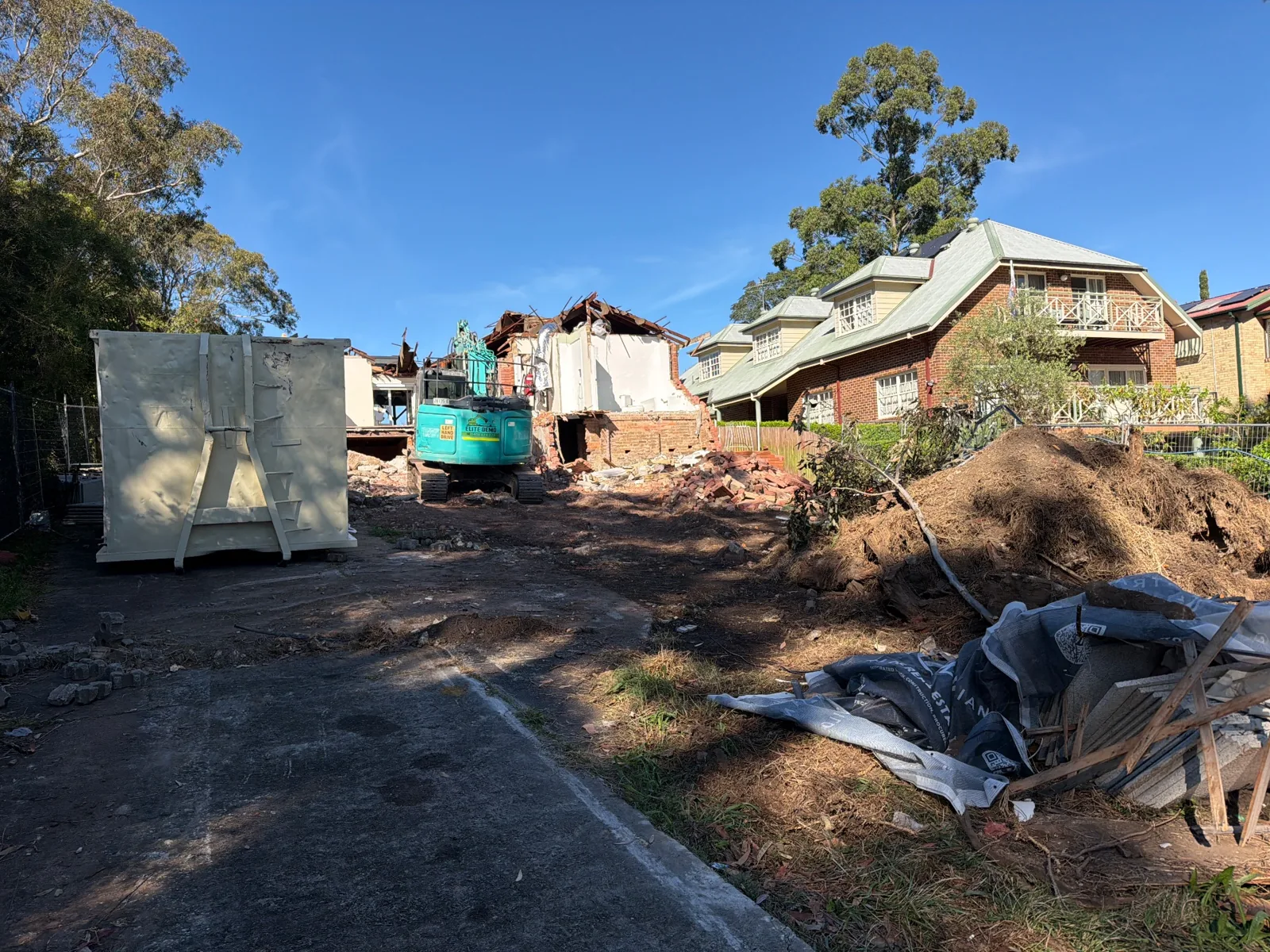

  2. The report still records the broken-down truck obstructing access and ongoing follow-up.

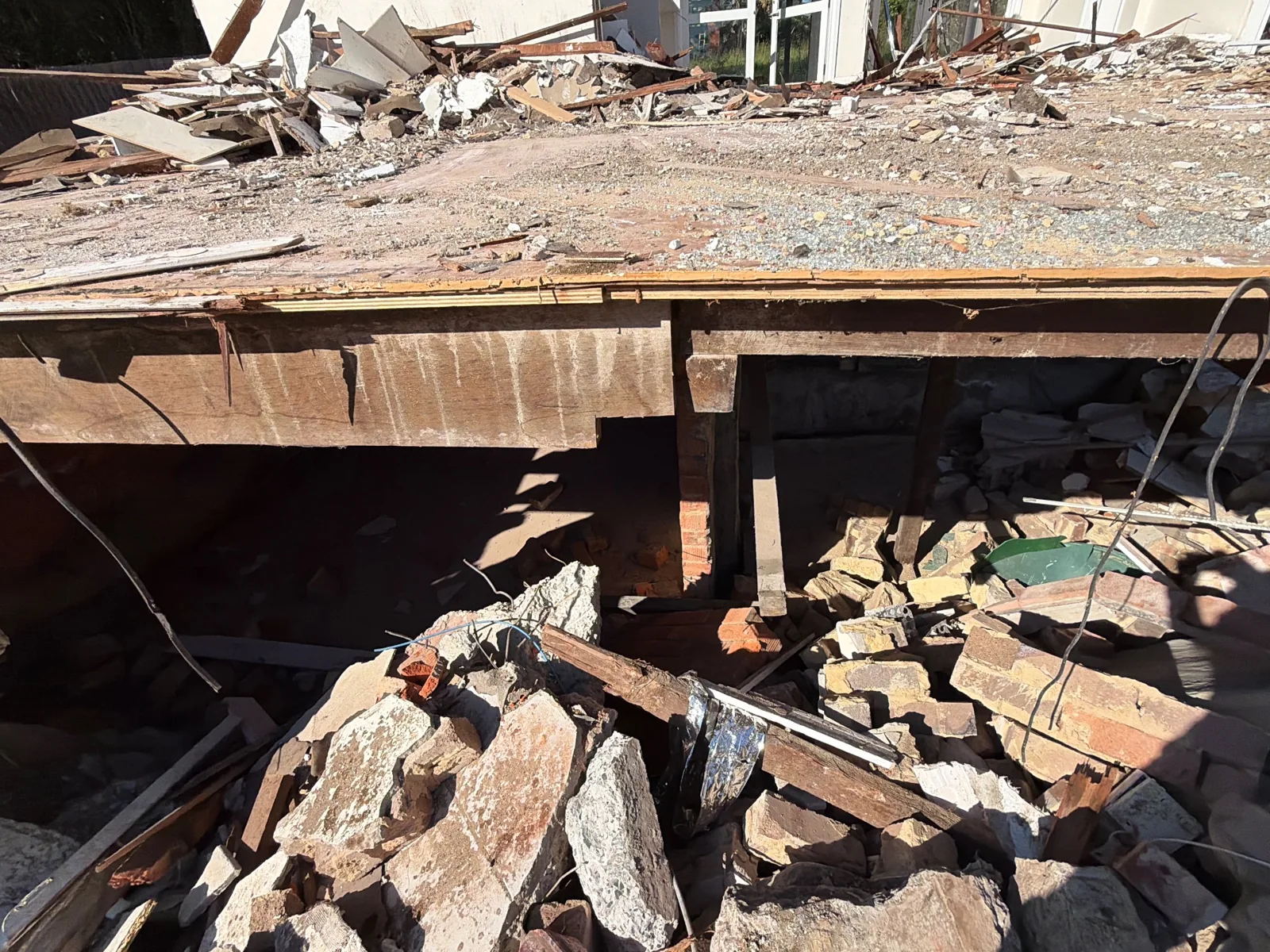

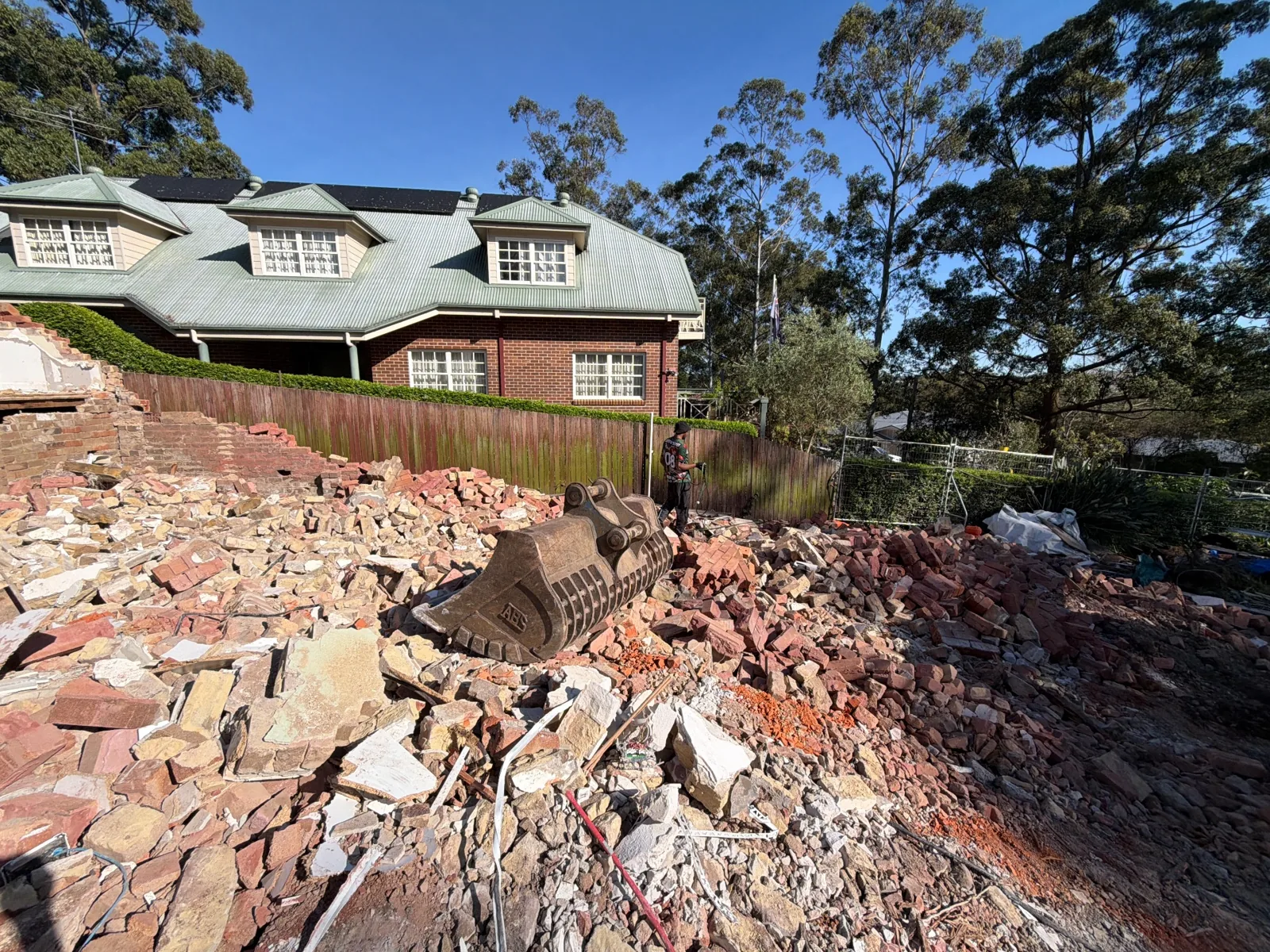

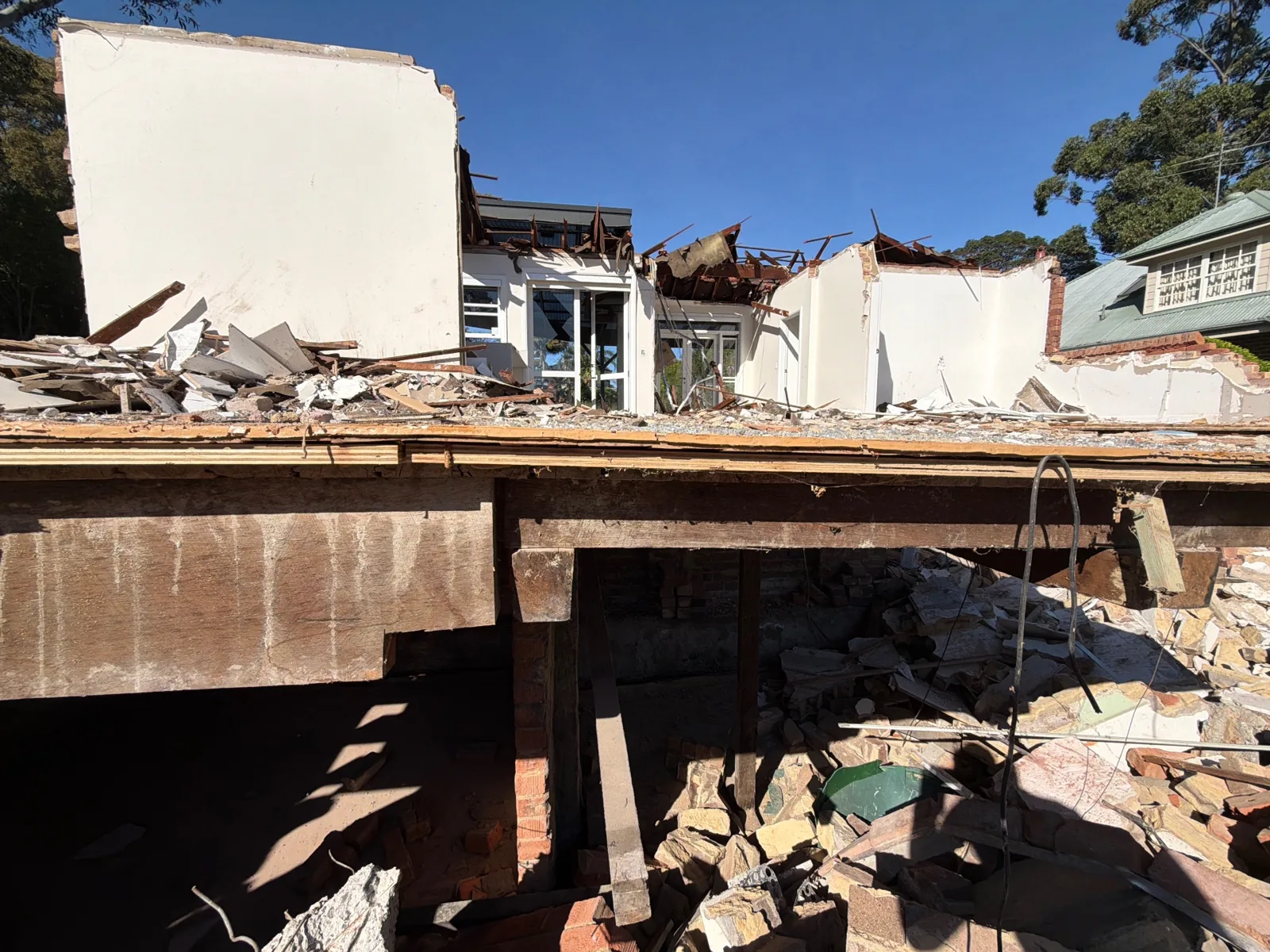

  3. The report and photographs show continuing demolition; this entry does not explicitly confirm closure of the access issue.

Photographs from the site

Dates come from the linked PM site record. Photographs show visible work and do not independently certify concealed work or inspection outcomes. Public images have EXIF/GPS metadata removed; originals and hashes are retained in the dossier.

Professional inspection report index

No original professional inspection report for this address is currently in this page’s dossier. Site progress, demolition tasks and scheme meetings are not professional acceptance findings.

Rectification and stage acceptance records

Management has confirmed stage acceptance and related rectification for completed work. This page does not yet have matching professional check/reinspection originals; progress photographs do not establish professional clearance.

Access coordination: the 30 September record describes a broken-down vehicle obstructing the entrance. The 1 October entry records continuing demolition without explicitly confirming this issue closed.

Sources and next steps

This page uses a read-only PM snapshot, the project master/construction task tables reviewed on 30 September 2026, and user-supplied inspection originals whose pages were reviewed. Management records and professional reports are identified separately; photographs were checked for project linkage and visible content.

Next: pair each work stage with its check, before/after rectification photographs and sign-off documents, then add stage-acceptance and whole-home handover records as obtained.

Explore all 11 project dossiers · Public evidence index

Bring your plans into the discussion

Choosing a custom-home or knockdown-rebuild builder? Share the site, drawings, approval status and material specification to discuss roles, work stages, quote inclusions and available site visits.

Discuss your build

Explore custom home construction · Knockdown rebuild scope and process · Compare builders on the same criteria

PM work schedules and site progress

Read-only extract on 1 October 2026. The table shows stored status, planned dates, actual-finish fields and the last sync date. Some imports predate the site diaries and are historical schedule snapshots. Status and actual-finish fields can differ; blanks remain blank. Planned dates do not establish completed construction or acceptance. Newer master records, professional inspections and signed close-outs are checked separately.

Recent site-record summaries

  1. — The daily record reports demolition continuing.
  2. — A broken-down truck remained at the driveway while the team followed up. The 1 October demolition record does not explicitly close out the access problem.
Open 1 stored PM schedule records, including older imports
Original task titleStored statusPlanned startPlanned finishActual-finish fieldLast sync
拆房?,道路/验收Recorded overdue2026-06-192026-07-14—2026-07-26

Request a site visit and document review — Subject to owner consent, site safety, work in progress and a confirmed time; a request is not a confirmed appointment.
